Independent public-interest researchEvidence dates shown with sources
Verified GIS

See what surrounds the proposed Pacifico site.

The Pacifico layer uses the eight exact tracts listed in J0049, with an optional georeferenced overlay of the OSSF-derived conceptual site plan. The map also shows the eastern FM 535 project and host parcels—including filed-address locators for Campus 2 and Campus 3—the MPH Bastrop Peakers host parcel, Earth Native's full five-parcel tract and shared property line, all 25 schools and early-childhood facilities, and 20 SpaceX / Gapped Bass parcels near FM 1209, FM 969 and Doc Bryson Lane. Three earlier ownership records are dashed and labeled unconfirmed. Separately, 3 resident-reported sales parcels have dotted amber outlines; the ranch's Musk connection and the Bar W pending sale remain unconfirmed. Privacy-safe community opposition, residential, drought, fire, and response context are also available. Two optional Central Texas layers add utility-scale power generation and large-scale data centers, with source-dated status and approximate locations labeled.

Content reviewed October 20, 2026 · Evidence dates appear with the records.

Verified GIS

See what surrounds the proposed Pacifico site.

The Pacifico layer uses the eight exact tracts listed in J0049.

Read moreRead less

An optional georeferenced overlay of the OSSF-derived conceptual site plan is available. The map also shows the eastern FM 535 project and host parcels—including filed-address locators for Campus 2 and Campus 3—the MPH Bastrop Peakers host parcel, Earth Native's full five-parcel tract and shared property line, all 25 schools and early-childhood facilities, and 20 SpaceX / Gapped Bass parcels near FM 1209, FM 969 and Doc Bryson Lane. Three earlier ownership records are dashed and labeled unconfirmed. Separately, 3 resident-reported sales parcels have dotted amber outlines; the ranch's Musk connection and the Bar W pending sale remain unconfirmed. Privacy-safe community opposition, residential, drought, fire, and response context are also available. Two optional Central Texas layers add utility-scale power generation and large-scale data centers, with source-dated status and approximate locations labeled.

Content reviewed October 20, 2026 · Evidence dates appear with the records.

Interactive regional map

Homes, 25 schools and learning facilities, major power projects, industrial parcels, drought, fire history—and response infrastructure

Pacifico, the Black Mountain / FWPC / ECX AUS31 parcel set, MPH Bastrop Peakers, Earth Native, school and childcare, SpaceX / Gapped Bass, residential, and public-community layers are on by default. Use Show local opposition for the privacy-safe broad-area totals, or open the layer control to add current drought intensity, farms and agricultural sites, ESD No. 1 station sites, the conceptual Pacifico layout, and other context. Opposition areas are intentionally generalized and are not household locations. Ownership parcels and the registered plan are not survey-grade or final building footprints, and jurisdiction boundaries do not establish staffing, apparatus, response time, water supply, or industrial-fire capability.

New: Central Texas power and data centers. Open the layer control to enable either regional layer. Both start off and keep the current zoom when enabled. Local regional pins may separate for selection, with limited dashed lines back to their recorded locations. Wide-area views allow overlap to preserve the geographic pattern. Use View Central Texas sites only when you want to zoom out.

Loading the verified GIS workspace…
Voluntary community opposition

106 supporters represented

The initial list represents 29 people at at least 16 locations. Exact street addresses are used only for private review and are never displayed publicly. The map shows anonymous totals inside fixed broad areas—not household pins or address-derived points.

106people opposing the proposal
86+represented locations
3broad map areas
What the count means

This is a voluntary supporter list, not a poll or a claim that every nearby resident agrees. Bubble locations and boundaries are fixed in advance and do not move in response to a submitted address.

Duplicate entries in the launch list were consolidated. New entries require a one-person attestation, confirmation through the private contact email, and organizer review against the launch list and queue. Multiple adults at one location may count as separate supporters, while the location counts once.

Lost Pines Watch does not ask for, collect or publish supporter names through this feature. After organizer approval, an anonymous count can be added to the selected broad-area bubble immediately; there is no five-entry batch or seven-day waiting period.

Count updated October 21, 2026
Add your support

Put your area on the map—without publishing your address.

We do not ask for or collect your name. Your address and email are used only for private review, duplicate checks and consent management—unless you separately opt in to email alerts below. After an organizer verifies the entry, the public map may add one anonymous count to a fixed broad-area bubble. Your exact address is never displayed anywhere on the public site.

The readable address is deleted as soon as an organizer approves and assigns a broad area. Entries still awaiting review after 90 days are removed during routine queue cleanup. A protected duplicate-check code and broad area remain; your email stays private so your entry can be confirmed or removed and, only if you opt in, used for Lost Pines Watch alert delivery until you unsubscribe. To limit spam, a non-readable network code rotates hourly and stale rate-limit rows are pruned after 48 hours during later submission activity.
OSSF-derived site plan

What the site layout appears to show

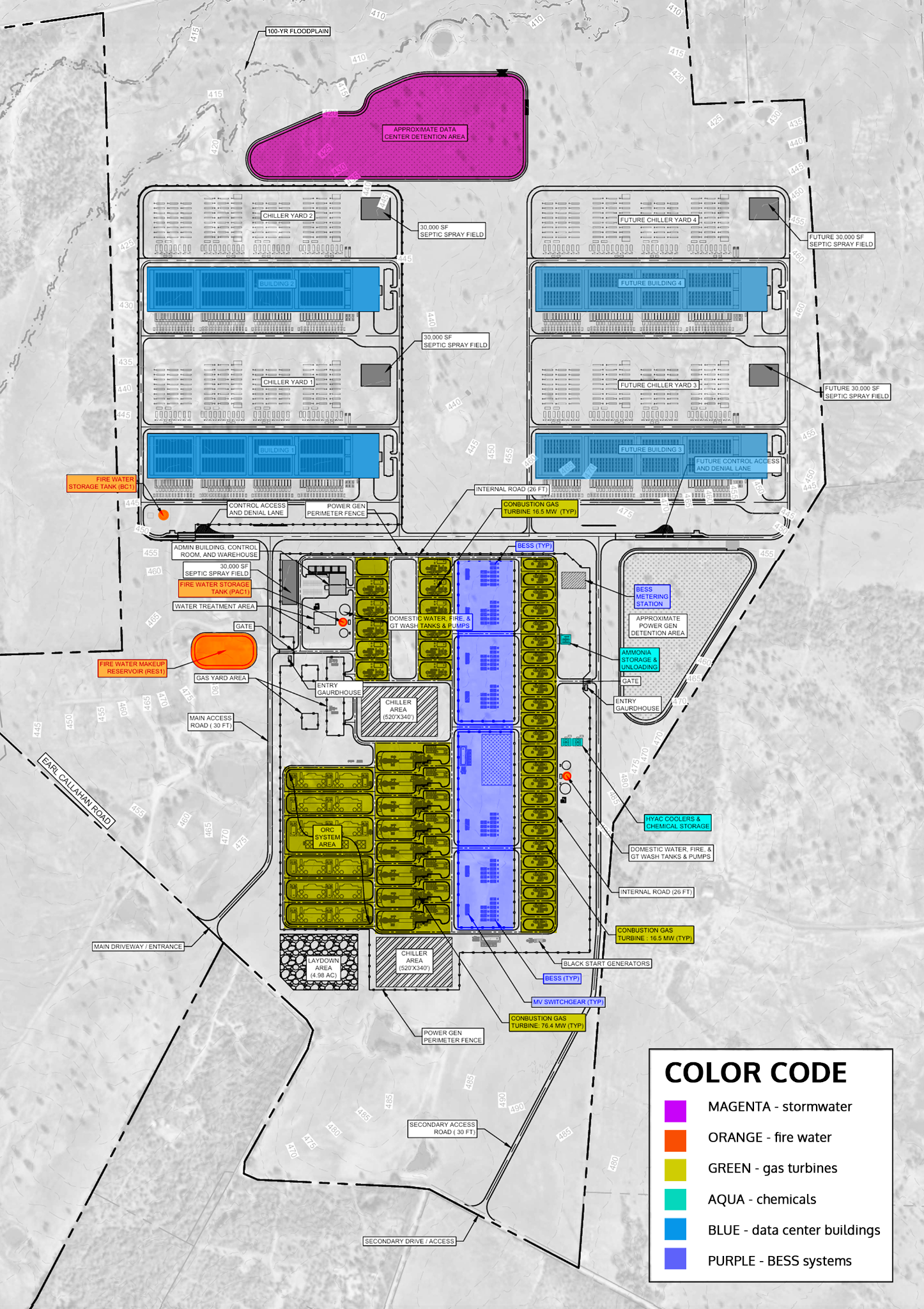

This colorized community annotation is based on “PACIFICO site plans 2 - stitched 1.png,” a stitched plan derived from the project’s on-site sewage facility filing. It helps separate the data-center, power, water, chemical, stormwater, and wastewater systems. The color is explanatory—not part of the filing.

Colorized Pacifico site plan showing data-center buildings, chiller yards, combustion gas turbines, battery storage, an ORC area, ammonia and chemical areas, fire-water systems, septic spray fields, and stormwater detention
Community-colorized copy. Labels and geometry are retained from the OSSF-derived source; the color overlays and legend were added for readability. Select the image to open the full-resolution file.
Source-file note

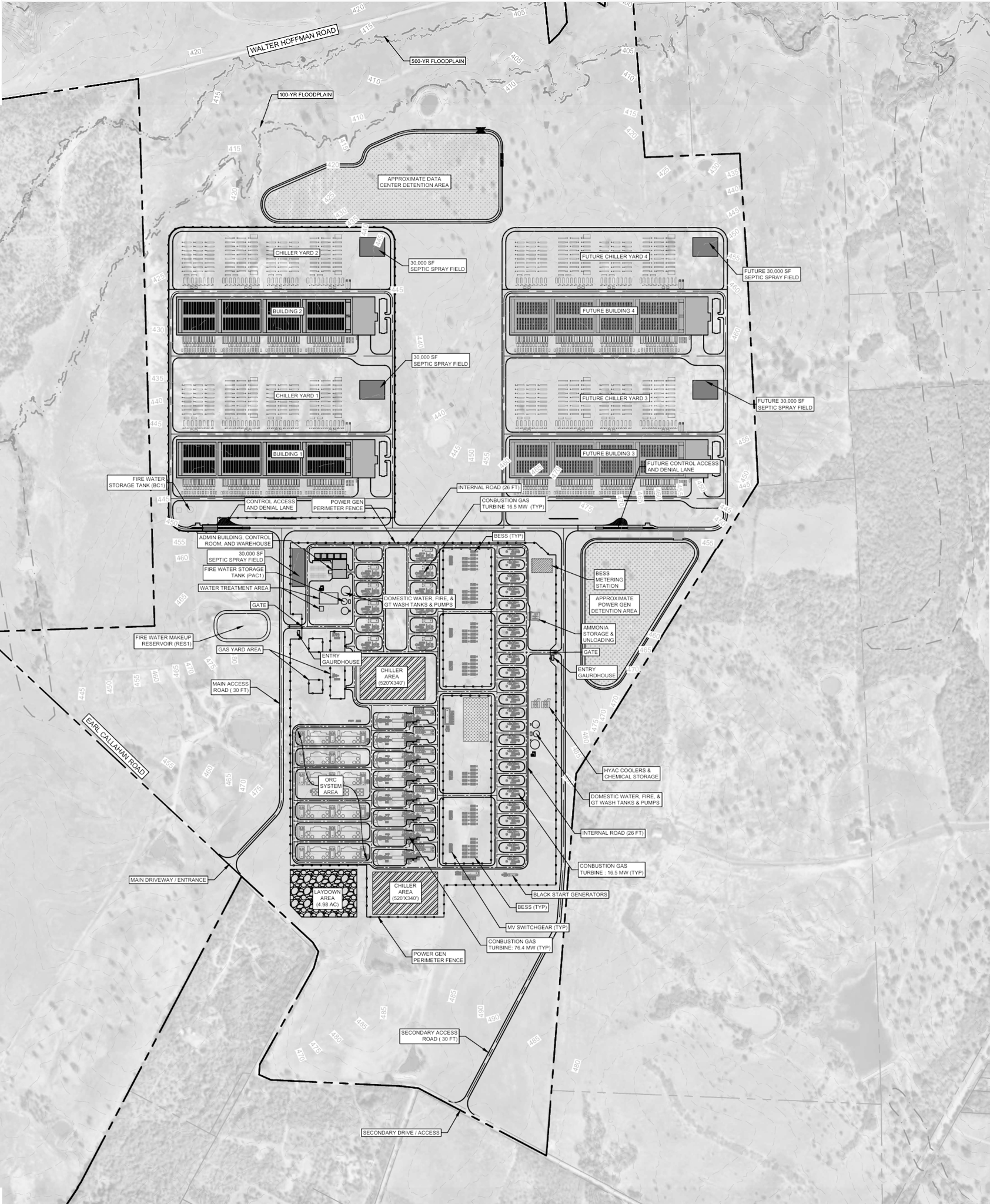

The uncolored source is preserved as PACIFICO site plans 2 - stitched 1.png. The colorized version is an interpretive overlay of that OSSF-derived image, not a replacement for it.

Shown on the drawing

Two gas-turbine rating labels; BESS; ORC; ammonia, chemical, cooling, fire-water, wastewater, and detention areas; and four data-center buildings, two marked future.

Not disclosed here

Equipment maker or model, final unit count, BESS capacity or duration, fuel route, emissions and noise totals, water balance, construction sequence, or operating schedule.

How “TYP” is treated

“TYP” usually means a label or detail applies to similar repeated features. It is not, by itself, a final count or proof that every repeated symbol will be built.

Site plan guide

Explanation of Site Components

Open the guide to see how the labeled systems probably work together, separating what the plan expressly labels from technically reasonable interpretation and details Pacifico has not disclosed.

Explore
01

Strong 76.4 MW candidate: Ansaldo AE64.3A

Direct Pacifico contract
Shown
“Combustion gas turbine: 76.4 MW (TYP)” and “combustion gas turbine: 16.5 MW (TYP).” The drawing does not identify the rating basis, manufacturer, or model.
Likely function
Different unit sizes could let an operator add generation in smaller steps, retain capacity during maintenance, and follow a changing campus load. That is a plausible design benefit—not a disclosed dispatch plan or proof of baseload-versus-peaking roles.
Strongest model evidence
Ansaldo Energia announced on July 20, 2026 that Pacifico Energy ordered exactly eight AE64.3A turbines in a 60 Hz configuration, with generators, for a Texas data-center power project. This plan appears to repeat eight larger turbine packages, while Ansaldo’s current brochure rates the AE64.3A at 78 MW under natural-gas ISO conditions. The plan’s 76.4 MW label is 1.6 MW, or about 2.1%, lower—a close match that could reflect a project-specific or net rating. Taken together, the developer, state, application, unit count, equipment class, and rating make the AE64.3A the strongest candidate found for the larger units.
Confidence limit
Ansaldo’s announcement does not name Cedar Creek, and Pacifico has more than one Texas data-center project. The OSSF-derived plan also does not state its rating basis or identify a manufacturer. This is therefore a strongly supported candidate—not a site-confirmed procurement record. The 16.5 MW model remains unresolved: its rating is close to the Solar Titan 130’s 16.53 MW ISO output and the Baker Hughes NovaLT16’s 16.9 MW power-generation output, but capacity alone cannot distinguish them.
02

BESS, metering, and medium-voltage switchgear

Likely function
Shown
Repeated “BESS (TYP)” areas, a BESS metering station, and “MV switchgear (TYP)” inside the power block.
Likely function
Battery storage could supply rapid-response power, bridge short changes while generators start or ramp, support ride-through, and stabilize an islanded campus. Switchgear would protect, isolate, and route medium-voltage circuits; the metering station would measure battery power exchange.
Still unknown
Battery chemistry, MW, MWh, duration, container count, operating purpose, electrical topology, setbacks, and fire-protection design.
03

ORC system area

High-confidence reading
Shown
A large “ORC system area” directly beside the larger turbine footprints.
Likely function
ORC most likely means Organic Rankine Cycle: a bottoming system that captures otherwise-wasted heat and converts some of it to additional electricity. Its placement makes turbine-exhaust heat recovery the most likely explanation.
Still unknown
Heat-source connections, working fluid, generating capacity, condenser and cooling method, or whether the ORC is included in either turbine MW label.
04

Ammonia storage and unloading

Likely emissions control
Shown
A dedicated “ammonia storage & unloading” area inside the power-generation fence.
Likely function
The most likely use is reagent supply for selective catalytic reduction, which injects ammonia or urea into exhaust to reduce nitrogen oxides. EPA identifies SCR as a widely used gas-turbine NOx control.
Still unknown
Ammonia concentration, storage volume, unloading frequency, containment and emergency safeguards, SCR layout, and permitted NOx or ammonia-slip limits.
05

Gas yard, black start, and plant restart

Likely function
Shown
A gas-yard area near the main entrance and labeled black-start generators near the switchgear.
Likely function
The gas yard would normally receive, meter, regulate, and condition fuel before it reaches the turbines. Black-start generators can energize essential plant equipment after a full shutdown without relying on the outside transmission network.
Still unknown
Pipeline route, delivery pressure, on-site gas compression, backup fuel, black-start generator type, rating, fuel, and runtime.
06

Chillers, HVAC coolers, and water systems

Two cooling contexts
Shown
Chiller Yards 1 and 2 beside Buildings 1 and 2; Future Chiller Yards 3 and 4; two 520-by-340-foot chiller areas in the power block; HVAC coolers and chemical storage; water treatment; and domestic, fire, and gas-turbine-wash tanks and pumps.
Likely function
The data-center chiller yards would reject heat from IT equipment. The separately fenced power-block cooling areas likely serve turbine, generator, ORC, inlet-air, or other plant auxiliaries. The labeled wash-water system likely supports turbine compressor cleaning.
Still unknown
Air-cooled versus evaporative equipment, design heat load, water consumption, chemical inventory, blowdown handling, redundancy, or which loads each power-block chiller serves.
07

Fire water, septic spray fields, and detention

Different water systems
Shown
Two fire-water storage tanks, a fire-water makeup reservoir, four 30,000-square-foot septic spray fields near the data halls, another 30,000-square-foot field in the power area, and separate data-center and power-generation detention areas.
Likely function
The fire-water features reserve water for suppression and system refill. OSSF spray fields disperse treated wastewater on site; they are not cooling ponds. Detention areas temporarily manage stormwater runoff.
Still unknown
Tank and reservoir volumes, refill source and rate, fire demand, wastewater design flow, treatment train, spray schedule, stormwater outlet design, or final authorization.
08

Phasing, access, and operations

Sequence suggested
Shown
Buildings and Chiller Yards 3 and 4 are marked “future.” The plan also shows fences, gates, guardhouses, control and denial lanes, an admin/control/warehouse building, internal roads, secondary access, and a 4.98-acre laydown area.
Likely function
The labels suggest staged data-center buildout while the access and laydown features support controlled construction, deliveries, maintenance, and daily industrial operations.
Still unknown
Formal phase boundaries, start dates, construction duration, staffing, truck volumes, gate schedules, emergency access, or whether power generation is phased with the data halls.
Bottom line

The plan strongly supports a tightly integrated data-center and on-site power campus with multiple turbine sizes, battery storage, heat recovery, probable emissions-control support, and substantial cooling and water infrastructure. The drawing itself does not identify a turbine model. A separate Ansaldo–Pacifico contract was once the strongest candidate evidence for the 76.4 MW units. The released air application now separately identifies 48 turbines across six model families, including eight Ansaldo AE64.3A units, and states 1,326 MW of maximum nominal output. The drawing does not establish final procurement, exact placement, operating profile, impacts, or approved terms.

Layer register

What is mapped—and what still requires evidence

Parcel, address-point, public-facility, and fire layers carry separate evidence labels. Residential records are deliberately stripped to coordinates only. Derived layers and incomplete reconciliations remain explicit.

Explore
ThemeLayerStatusSource or requirement
Regional projectsCentral Texas utility-scale power generationDated EIA snapshot + project recordsGeneration sites of at least 10 MW, plus proposals with unverified capacity; all fuels and development stages. Optional; preserves the initial map view.
Regional projectsCentral Texas large-scale data centersSource-linked campus inventoryOperating campuses, construction and publicly documented proposals; approximate locations explicitly labeled. Optional; does not change the initial map view.
ProjectPacifico filed project areaVerified snapshotEight exact J0049 tracts + Bastrop County GIS geometry
ProjectConceptual Pacifico site layoutDerivedOSSF-derived applicant plan affinely aligned to fixed aerial features; approximate, not a survey or final construction footprint
Adjacent landEarth Native full tract and shared property lineVerified snapshotFive contiguous CAD parcels totaling 103.721 legal acres; approximately 2,160-foot shared line with J0049 parcel 24484
ProjectsSpaceX and Gapped Bass parcelsCAD + recorded deed + labeled prior records20 mapped parcels near FM 1209 / FM 969 and Doc Bryson Lane; 17 confirmed current-owner records total 1,202.467 CAD legal acres. Parcel 121670 is confirmed by SpaceX deed 202609629, recorded June 8, 2026, despite an outdated CAD owner field. 3 prior records remain dashed. Updated September 27, 2026.
ManufacturingSpaceX factory · aluminum furnace permitPrimary records; permit pendingSX marker: TCEQ facility point for 858 FM 1209, RN111897583. Permit 182733 covers aluminum melting and holding furnaces. Separate SpaceX job postings confirm Bastrop turbine-blade plans, but the foundry parcel and a link to this permit remain unconfirmed. Checked October 1, 2026.
Reported salesColorado River Ranch and Bar W Ranch parcelsResident-reported; key claims unconfirmed3 dotted amber outlines, excluded from confirmed SpaceX / Gapped Bass totals. Parcel 133579 (314.17 acres): sale to Colorado River Ranch LLC recorded June 1, 2026; Musk connection reported, not confirmed. Bar W parcels 51141 (453.384 acres) and 35704 (347.862 acres): resident-reported pending sale; buyer and pending status unconfirmed.
ProjectsEdgeConneX site and host tractsCAD-derived snapshotAUS01 Unit 1/common area (~63.45 mapped acres) and Units 2–4 (~37.96 mapped acres), with LCRA parcel 24749 excluded; checked October 1, 2026. Plus the 179-acre 6682 FM 535 tract used by EDCAUS11, EDCAUS12, EDCAUS13 and EDCAUS14
ProjectsEastern FM 535 project and host parcelsCurrent CAD/deed snapshotR35120 and R25532 are EdgeConneX Property 7-owned; R34648 hosts the EDCAUS31/32 filed address and R55674 hosts the EDCAUS15/16 filed address while remaining Uppingham-owned and dashed. Four-parcel total: 3,178.588 legal acres.
ProjectsAmazon Data Services assemblageCAD-derived snapshotHistorical CTX/Creekside assemblage (~1,327 mapped acres); exact current Amazon ownership and conveyance remain under deed reconciliation
ProjectsMPH Bastrop Peakers host parcelVerified snapshotBastrop CAD property 85993; permitted 1,170 MW expansion; TCEQ air permits signed March 25, 2026; J0033 remains in Application Phase
ProjectsAUS02 and eight EDCAUS filings at three address locatorsVerifiedTDLR filings for AUS02, EDCAUS11, EDCAUS12, EDCAUS13, EDCAUS14, EDCAUS15, EDCAUS16, EDCAUS31 and EDCAUS32 + verified address points
CommunityVoluntary opposition shown in broad areasCommunity list + moderated opt-ins29 people in the launch count; no names are collected, and exact addresses are never displayed publicly
CommunityAnonymous residential address pointsPrivacy-safe snapshot5,701 points within 3 miles; all names, addresses, ownership, and submissions removed
CommunitySchools and childcareMixed verificationAll 25 schools and early-childhood facilities, with current names, addresses, licensing evidence, co-locations, and unconfirmed records labeled separately
CommunityFarms and agricultural sitesPrivacy-safe snapshotNamed public farms + anonymized county-classified agricultural points
CommunityChurches, parks, cemeteries, care and response sitesReference snapshotPublic-place locations from the supplied community-impact dataset
Environmental stressCurrent U.S. Drought Monitor intensityLiveLatest weekly USDM polygons; select a feature for its own classification, valid date and release date
Fire2011 Bastrop Complex perimeterVerified snapshotBastrop County GIS
Fire2015 Hidden Pines perimeterVerified snapshotBastrop County GIS
EmergencyBastrop County ESD No. 1 station sitesVerified snapshot7 recorded facilities across a 395-square-mile response area; Texas FireConnect verified February 6, 2026
EmergencyFive-mile station distance guidesDerivedStraight-line facility proximity only; not drive time, response time, staffing, or capability
EmergencyFire service and responder boundariesLiveBastrop County GIS
Analysis1 / 2 / 3 / 5 mile perimeter offsetsDerivedMeasured outward from Pacifico’s filed project boundary
ProjectsAmazon conveyed-tract deed reconciliationVerifyThe CAD-derived approximately 1,300-acre union is mapped; recorded deeds remain authoritative for the exact conveyance
RiskWildland fuel modelsNextTexas A&M Forest Service / LANDFIRE
InfrastructureTransmission and substationsResearchingERCOT, utilities, county records
InfrastructureNatural-gas pipelinesResearchingRRC and operator records
WaterWells, service areas, and supplyResearchingLPGCD, Aqua WSC, TWDB
MobilityRoads, access, and evacuationResearchingTxDOT and county records
CommunityExact supporter addresses, emails, and unapproved submissionsNever publicOnly anonymous counts inside fixed broad-area bubbles are displayed
School and early-childhood register

25 mapped school, childcare and learning-program entries—within about four miles

4 are within about one mile. Some entries have unconfirmed current operating status. Earth Native Wilderness School is immediately adjacent, and its property shares the project boundary. Co-located programs have separate selectable markers; tiny display offsets do not change their listed addresses or measured distances.

Explore
#School or early-childhood facilityPublic addressDistanceEvidence status
1Cedar Creek Elementary School
Bastrop ISD elementary campus
5582 FM 535, Cedar Creek, TX 786123.2 miVerified current campus
Current Bastrop ISD directory address.
2Cedar Creek Intermediate School / Creekside Middle School
Bastrop ISD middle-school campus
151 Voss Pkwy, Cedar Creek, TX 786122.2 miVerified address; current name corrected
Bastrop ISD currently identifies the 151 Voss campus as Creekside Middle School; Cedar Creek Intermediate is retained as an alternate name.
3Cedar Creek Middle School
Bastrop ISD middle-school campus
125 Voss Pkwy, Cedar Creek, TX 786122.1 miVerified current campus
Current Bastrop ISD directory address.
4Cedar Creek High School
Bastrop ISD high-school campus
793 Union Chapel Rd, Cedar Creek, TX 786123.8 miVerified current campus
Current Bastrop ISD directory address.
5Covenant Christian School
Private school
120 N Gaines Rd, Cedar Creek, TX 786121.0 miCurrent operation unconfirmed
The resident-supplied address geocodes exactly, but a current operating-school record was not independently located.
6Learning Lions Christian School
Private early-childhood school
1168 Walter Hoffman Rd, Cedar Creek, TX 786121.0 miVerified current program
The school publishes this address and describes full-time care for ages 2–5.
7Colony Oaks Elementary School
Bastrop ISD elementary campus
601 Sam Houston Dr, Bastrop, TX 786023.0 miVerified current campus
Current Bastrop ISD directory address.
8Adelton Elementary
Bastrop ISD elementary campus
119 Blume Dr, Bastrop, TX 786022.5 miVerified current campus
Bastrop ISD lists 119 Blume Drive; the new street is not yet resolved by the public geocoder, so the campus point uses the district's previously published map location.
9Calvary Episcopal School
Private Episcopal school
107 Lost Oaks Trail, Bastrop, TX 786023.7 miVerified current campus
Spelling corrected from 'Cavalry.' The school moved to this campus in January 2026.
10Founders Classical Academy – Bastrop
Public charter school
415 Shiloh Rd, Bastrop, TX 786022.2 miVerified current campus
The academy's current official Bastrop page lists this address.
11Earth Native Wilderness School / Wild Life Forest Preschool
Outdoor education and forest preschool campus
921 Shiloh Rd, Bastrop, TX 786020.1 miVerified current campus
Earth Native publishes both Shiloh and Woodview entrances and states that its program is not a licensed child-care facility.
12Children's Town Center
Licensed child-care center
112 Voss Pkwy, Cedar Creek, TX 786122.0 miLicensing-search location
Public child-care licensing search location; verify current details in the state record.
13Sweetpea Learning Center
Licensed child-care center
104 Union Chapel Rd, Cedar Creek, TX 786121.0 miLicensing-search location
Public child-care licensing search location; verify current details in the state record.
14Cedar Creek Child Care Center
Licensed child-care center
5630 FM 535, Cedar Creek, TX 786123.3 miLicensing-search location
Public child-care licensing search location; verify current details in the state record.
15Cedar Creek Head Start
Head Start / early-childhood program
5582 FM 535, Cedar Creek, TX 786123.2 miCurrent program record unconfirmed
This co-location is mapped, but a current standalone Head Start record at this campus was not independently verified.
16BISD District Day Care @ Cedar Creek Elementary
Bastrop ISD child development center
5582 FM 535, Cedar Creek, TX 786123.2 miVerified district co-location
Cedar Creek Elementary's official page says the campus houses one of Bastrop ISD's two Child Development Centers.
17BISD Cedar Creek Middle Daycare
School-based child-care program
151 Voss Pkwy, Cedar Creek, TX 786122.2 miCurrent program record unconfirmed
This co-location is mapped. Bastrop ISD currently calls this campus Creekside Middle School, and a current daycare program record was not independently located.
18BISD Beyond the Bell / STARS at Cedar Creek Elementary
Bastrop ISD after-school program
5582 FM 535, Cedar Creek, TX 786123.2 miVerified district co-location
The campus bell schedule identifies STARS dismissal; the marker is offset only so the co-located program can be selected.
19Small Treasures In-Home Child Care
Registered or listed in-home child care
204 Martin Crossing Dr, Cedar Creek, TX 786120.6 miLicensing-search location
This is a public-facing child-care operation address from the state search; no resident or household ownership data are attached.
20Busy Bee Academy
Licensed child-care center
1116 Highway 71 W, Bastrop, TX 786021.5 miVerified state operation
Texas child-care operation 1627657; address independently cross-checked.
21Legacy Educational Center (Legacy Childcare)
Licensed child-care center
636 Highway 304, Bastrop, TX 786023.6 miVerified state operation
The current Bastrop record is Legacy Educational Center, Texas child-care operation 1803399; Legacy Childcare is retained as an alternate name.
22Bastrop Montessori
Private Montessori school and preschool
875 Highway 71 W, Bastrop, TX 786022.4 miVerified current campus
The school’s current website lists this campus, programs for ages 18 months through sixth grade, and a 2026–27 school calendar.
23Bluebonnet Elementary School
Bastrop ISD elementary campus
416 FM 1209, Bastrop, TX 786022.5 miVerified current campus
The official campus page lists this address; its location was checked with an exact public address-geocoder match on September 22, 2026.
24Compass Rose Harvest
Public charter school
118 Stephen F. Austin Blvd, Bastrop, TX 786021.7 miVerified current campus
The official campus page lists this address; its location was checked with an exact public address-geocoder match on September 22, 2026.
25Childrens Town Center #2
Licensed child-care center
374 FM 1209, Bastrop, TX 786022.2 miVerified active license
HHSC operation 1487297: active, capacity 60, full permit issued February 18, 2025; checked October 1, 2026. Separate from the 112 Voss Pkwy center. Exact address-geocoder match; distance measured to Pacifico’s filed tract boundary.
Pacifico tract register

The eight tracts identified in the application

J0049 page 7 identifies each Bastrop County Appraisal District property ID, legal description, and common project address. These are the tracts rendered in the live Pacifico layer.

Explore
Property IDLegal descriptionFiled acreageMap status
24484A225 LEVERENCE, L.1,451.6100 acresMapped
73556A225 LEVERENCE, L.61.7334 acresMapped
82519A225 LEVERENCE, L.291.1566 acresMapped
42020A338 WALTERS, JACOB993.4300 acresMapped
73320A225 LEVERENCE, L.1.5126 acresMapped
90755A83 BYMER, BERNARD2.8550 acresMapped
42286A375 LITTON, ADDISON7.6300 acresMapped
92335A83 BYMER, BERNARD0.1277 acresMapped
Filed legal-description total2,810.0553 acresApplicant narrative states approximately 2,842 acres
Regional projects · inventory reviewed October 20, 2026

Central Texas power generation, data centers and permit records

Explore operating, under-construction and proposed projects across Central Texas, plus equipment and emissions records for nearby power plants. Status, location accuracy and evidence dates are labeled separately.

Explore

Regional project inventory

84 generation records and 49 data center projects across 31 counties, with scope and source links below.

Reviewed October 20, 2026. The power baseline is the August 2026 EIA-860M operating and planned generator inventory, supplemented by dated project records. This map shows generation sites with at least 10 MW of reported operating or proposed generating capacity, plus labeled major proposals whose capacity remains undisclosed or unverified. Large on-site generation and combined heat and power are included. Sites with known capacity below 10 MW, storage-only sites and retired sites are excluded. Data centers include major hyperscale, colocation, AI and industrial computing campuses, including labeled cryptocurrency sites. This is a documented inventory rather than an exhaustive registry; private or undisclosed proposals may be missing.

Study area (31 counties): Bastrop, Bell, Bexar, Blanco, Burleson, Burnet, Caldwell, Colorado, Comal, Coryell, Falls, Fayette, Gillespie, Gonzales, Guadalupe, Hamilton, Hays, Kendall, Kerr, Lampasas, Lavaca, Lee, Llano, Mason, McLennan, Milam, Mills, San Saba, Travis, Washington, Williamson.

Status is the latest evidence found for each record, not a live construction inspection. A filed start date or announced target does not prove construction. Operating campuses may also have proposed expansions. Approximate town or area pins do not identify a particular property; none of these points is a surveyed project boundary. Power generation, critical IT load, utility service and possible full buildout are different measures and should not be added together. A substation does not generate electricity, and a nearby power plant is not necessarily dedicated to a data center. The Caldwell Power Generation Plant filing is flagged because its capacity and operating role are unverified. Austin Energy’s announced 400 MW peaker program uses an Austin-area placeholder because its sites have not been disclosed.

Power generation sites
  • Bastrop County Power Plant / Fort Worth Power Core

    Planned / permitting / discussion · Bastrop County

    Permitted / construction unconfirmed; Permitted / construction unconfirmed

    Natural gas · Natural gas generation · Capacity unreported / not verified

    Location: TCEQ registered coordinate 30.116,-97.556; not an equipment survey

    Operator: Original applicant:Fort Worth Power Core LLC. Registration 178505 issuedDecember 20, 2024, expiresDecember 20, 2034. Six gas combustion turbine generators and two heat-recovery steam generators authorized. Capacity measures reported elsewhere differ; not assigned here without reconciling permit rating. Point is TCEQ registered location inside EdgeConneX Property 7 parcel R35120. Does not prove equipment construction or current customer-record affiliation.

    Evidence date: Reviewed October 20, 2026

    TCEQ issuance letter and emissions tableBastrop CAD R35120
  • Bastrop Energy Center

    Operating · Bastrop County

    Operating (EIA August 2026); (OP) Operating

    Natural gas · Natural Gas Fired Combined Cycle · 618.7 MW generator nameplate

    Location: EIA-reported plant coordinate; not a surveyed boundary

    Operator: Bastrop Energy Partners, LP. EIA sector: IPP Non-CHP. Includes generators reported operating in EIA-860 M; standby, out-of-service, retired and storage units excluded.

    Evidence date: EIA August 2026 snapshot, released September 24, 2026; reviewed October 20, 2026

    EIA-860M August 2026 inventory (released September 24, 2026)EIA inventory methodology
  • Big Star Solar, LLC (Hybrid)

    Operating · Bastrop County

    Operating (EIA August 2026); (OP) Operating

    Solar · Solar Photovoltaic · 200 MW generator nameplate

    Location: EIA-reported plant coordinate; not a surveyed boundary

    Operator: RWE Clean Energy. EIA sector: IPP Non-CHP. Includes generators reported operating in EIA-860 M; standby, out-of-service, retired and storage units excluded.

    Evidence date: EIA August 2026 snapshot, released September 24, 2026; reviewed October 20, 2026

    EIA-860M August 2026 inventory (released September 24, 2026)EIA inventory methodology
  • Lost Pines 1 Power Project

    Operating · Bastrop County

    Operating (EIA August 2026); (OP) Operating

    Natural gas · Natural Gas Fired Combined Cycle · 609 MW generator nameplate

    Location: EIA-reported plant coordinate; not a surveyed boundary

    Operator: Lower Colorado River Authority. EIA sector: Electric Utility. Includes generators reported operating in EIA-860 M; standby, out-of-service, retired and storage units excluded.

    Evidence date: EIA August 2026 snapshot, released September 24, 2026; reviewed October 20, 2026

    EIA-860M August 2026 inventory (released September 24, 2026)EIA inventory methodology
  • MPH Bastrop Peakers expansion

    Planned / permitting / discussion · Bastrop County

    Permitted expansion / construction unconfirmed; Permitted expansion / construction unconfirmed

    Natural gas · Natural gas generation · Up to 1,170 MW proposed

    Location: Approximate site/campus point; equipment footprint not confirmed

    Operator: MPH Bastrop Peakers LLC / MilePost Power. Six additional gas turbines at 195 MW each proposed within existing Bastrop Energy Center host property. TCEQ permits 178585, PSDTX1658, GHGPSDTX247 signedMarch 25, 2026 per existing linked site record. Existing plant is separately mapped from EIA;1,170 MW here is additional proposed capacity, not current output. Filed start dates and signed permits do not prove construction has begun.

    Evidence date: Reviewed October 20, 2026

    TCEQ preliminary determinationLost Pines Watch mapped permit and parcel record
  • Pacifico Cedar Creek proposed power plant

    Planned / permitting / discussion · Bastrop County

    Proposed / air-permit application; Proposed / air-permit application

    Natural gas · Natural gas generation · Up to 1,326 MW proposed

    Location: Approximate site/campus point; equipment footprint not confirmed

    Operator: Pacifico Energy / Pacifico Cedar Creek Power. Filed air application describes 48 gas turbines totaling 1,326 MW maximum nominal output. Older JETI 710 MW figures describe an earlier proposal. Approximate campus point, not final turbine pads. Onsite generation proposed to serve associated data center. Governor-directed permit pause does not mean canceled.

    Evidence date: Reviewed October 20, 2026

    Released Pacifico air application · 48 turbines / 1,326 MWTCEQ Project 413471 / Registration 185019Original J0049 application (earlier710 MW concept)Permitting pause context and sources
  • Sim Gideon

    Operating · Bastrop County

    Operating (EIA August 2026); (OP) Operating

    Natural gas · Natural Gas Steam Turbine · 623 MW generator nameplate

    Location: EIA-reported plant coordinate; not a surveyed boundary

    Operator: Lower Colorado River Authority. EIA sector: Electric Utility. Includes generators reported operating in EIA-860 M; standby, out-of-service, retired and storage units excluded.

    Evidence date: EIA August 2026 snapshot, released September 24, 2026; reviewed October 20, 2026

    EIA-860M August 2026 inventory (released September 24, 2026)EIA inventory methodology
  • Big Elm Solar

    Operating · Bell County

    Operating (EIA August 2026); (OP) Operating

    Solar · Solar Photovoltaic · 200 MW generator nameplate

    Location: EIA-reported plant coordinate; not a surveyed boundary

    Operator: Big Elm Solar, LLC. EIA sector: IPP Non-CHP. Includes generators reported operating in EIA-860 M; standby, out-of-service, retired and storage units excluded.

    Evidence date: EIA August 2026 snapshot, released September 24, 2026; reviewed October 20, 2026

    EIA-860M August 2026 inventory (released September 24, 2026)EIA inventory methodology
  • Chillingham Solar

    Operating · Bell County

    Operating (developer project page); ENGIE project page lists solar commercial operation 2024; EIA August 2026 entry remains commissioning.

    Solar · Solar Photovoltaic · 350 MW generator nameplate

    Location: EIA-reported plant coordinate; not a surveyed boundary

    Operator: Chillingham Solar LLC. EIA sector: IPP Non-CHP. Developer schedule/status reported to EIA. Planned operation dates and permit activity do not establish construction or commercial operation. Operator page contains conflicting introductory county/year boilerplate; use EIA Bell County coordinates and explicit commercial-operation field. Solar 350 MW; paired 150 MW storage excluded.

    Evidence date: EIA August 2026 snapshot, released September 24, 2026; reviewed October 20, 2026

    EIA-860M August 2026 inventory (released September 24, 2026)EIA inventory methodologyENGIE Chillingham: commercial-operation field
  • Cosper Solar

    Planned / permitting / discussion · Bell County

    Planned (EIA August 2026); (L) Regulatory approvals pending. Not under construction

    Solar · Solar Photovoltaic · 148.2 MW generator nameplate

    Location: EIA-reported plant coordinate; not a surveyed boundary

    Operator: Gransolar Texas Twenty LLC. EIA sector: IPP Non-CHP. Developer schedule/status reported to EIA. Planned operation dates and permit activity do not establish construction or commercial operation.

    Evidence date: EIA August 2026 snapshot, released September 24, 2026; reviewed October 20, 2026

    EIA-860M August 2026 inventory (released September 24, 2026)EIA inventory methodology
  • Five Wells Solar Center - Hybrid

    Operating · Bell County

    Operating (EIA August 2026); (OP) Operating

    Solar · Solar Photovoltaic · 355.4 MW generator nameplate

    Location: EIA-reported plant coordinate; not a surveyed boundary

    Operator: Five Wells Solar Center, LLC. EIA sector: IPP Non-CHP. Includes generators reported operating in EIA-860 M; standby, out-of-service, retired and storage units excluded.

    Evidence date: EIA August 2026 snapshot, released September 24, 2026; reviewed October 20, 2026

    EIA-860M August 2026 inventory (released September 24, 2026)EIA inventory methodology
  • Hermes Solar PV

    Under construction · Bell County

    Construction / commissioning (EIA August 2026); (V) Under construction, more than 50 percent complete

    Solar · Solar Photovoltaic · 100.4 MW generator nameplate

    Location: EIA-reported plant coordinate; not a surveyed boundary

    Operator: Bell 1 Solar, LLC. EIA sector: IPP Non-CHP. Developer schedule/status reported to EIA. Planned operation dates and permit activity do not establish construction or commercial operation.

    Evidence date: EIA August 2026 snapshot, released September 24, 2026; reviewed October 20, 2026

    EIA-860M August 2026 inventory (released September 24, 2026)EIA inventory methodology
  • Limewood Bell Renewables Solar

    Under construction · Bell County

    Construction / commissioning (EIA August 2026); (TS) Construction complete, but not yet in commercial operation

    Solar · Solar Photovoltaic · 204 MW generator nameplate

    Location: EIA-reported plant coordinate; not a surveyed boundary

    Operator: Limewood Bell Renewables LLC. EIA sector: IPP Non-CHP. Developer schedule/status reported to EIA. Planned operation dates and permit activity do not establish construction or commercial operation.

    Evidence date: EIA August 2026 snapshot, released September 24, 2026; reviewed October 20, 2026

    EIA-860M August 2026 inventory (released September 24, 2026)EIA inventory methodology
  • Phantom Solar

    Operating · Bell County

    Operating (EIA August 2026); (OP) Operating

    Solar · Solar Photovoltaic · 15.4 MW generator nameplate

    Location: EIA-reported plant coordinate; not a surveyed boundary

    Operator: Phantom Solar, LLC. EIA sector: IPP Non-CHP. Includes generators reported operating in EIA-860 M; standby, out-of-service, retired and storage units excluded.

    Evidence date: EIA August 2026 snapshot, released September 24, 2026; reviewed October 20, 2026

    EIA-860M August 2026 inventory (released September 24, 2026)EIA inventory methodology
  • Stillhouse Solar

    Operating · Bell County

    Operating (EIA August 2026); (OP) Operating

    Solar · Solar Photovoltaic · 210 MW generator nameplate

    Location: EIA-reported plant coordinate; not a surveyed boundary

    Operator: Stillhouse Solar LLC. EIA sector: IPP Non-CHP. Includes generators reported operating in EIA-860 M; standby, out-of-service, retired and storage units excluded.

    Evidence date: EIA August 2026 snapshot, released September 24, 2026; reviewed October 20, 2026

    EIA-860M August 2026 inventory (released September 24, 2026)EIA inventory methodology
  • Temple Power Station

    Operating · Bell County

    Operating (EIA August 2026); (OP) Operating

    Natural gas · Natural Gas Fired Combined Cycle · 1,606.4 MW generator nameplate

    Location: EIA-reported plant coordinate; not a surveyed boundary

    Operator: Temple Generation Holdings LLC. EIA sector: IPP Non-CHP. Includes generators reported operating in EIA-860 M; standby, out-of-service, retired and storage units excluded.

    Evidence date: EIA August 2026 snapshot, released September 24, 2026; reviewed October 20, 2026

    EIA-860M August 2026 inventory (released September 24, 2026)EIA inventory methodology
  • Arthur Von Rosenberg

    Operating · Bexar County

    Operating (EIA August 2026); (OP) Operating

    Natural gas · Natural Gas Fired Combined Cycle · 575 MW generator nameplate

    Location: EIA-reported plant coordinate; not a surveyed boundary

    Operator: City of San Antonio - (TX). EIA sector: Electric Utility. Includes generators reported operating in EIA-860 M; standby, out-of-service, retired and storage units excluded.

    Evidence date: EIA August 2026 snapshot, released September 24, 2026; reviewed October 20, 2026

    EIA-860M August 2026 inventory (released September 24, 2026)EIA inventory methodology
  • Blue Wing Solar Energy Generation

    Operating · Bexar County

    Operating (EIA August 2026); (OP) Operating

    Solar · Solar Photovoltaic · 13.9 MW generator nameplate

    Location: EIA-reported plant coordinate; not a surveyed boundary

    Operator: Deriva Energy. EIA sector: IPP Non-CHP. Includes generators reported operating in EIA-860 M; standby, out-of-service, retired and storage units excluded.

    Evidence date: EIA August 2026 snapshot, released September 24, 2026; reviewed October 20, 2026

    EIA-860M August 2026 inventory (released September 24, 2026)EIA inventory methodology
  • El Patrimonio

    Planned / permitting / discussion · Bexar County

    Planned (EIA August 2026); (L) Regulatory approvals pending. Not under construction

    Solar · Solar Photovoltaic · 150 MW generator nameplate

    Location: EIA-reported plant coordinate; not a surveyed boundary

    Operator: Heritage Solar LLC. EIA sector: IPP Non-CHP. Developer schedule/status reported to EIA. Planned operation dates and permit activity do not establish construction or commercial operation.

    Evidence date: EIA August 2026 snapshot, released September 24, 2026; reviewed October 20, 2026

    EIA-860M August 2026 inventory (released September 24, 2026)EIA inventory methodology
  • J K Spruce

    Operating · Bexar County

    Operating (EIA August 2026); (OP) Operating

    Coal · Conventional Steam Coal · 1,488.5 MW generator nameplate

    Location: EIA-reported plant coordinate; not a surveyed boundary

    Operator: City of San Antonio - (TX). EIA sector: Electric Utility. Includes generators reported operating in EIA-860 M; standby, out-of-service, retired and storage units excluded.

    Evidence date: EIA August 2026 snapshot, released September 24, 2026; reviewed October 20, 2026

    EIA-860M August 2026 inventory (released September 24, 2026)EIA inventory methodology
  • Leon Creek

    Operating · Bexar County

    Operating (EIA August 2026); (OP) Operating

    Natural gas · Natural Gas Fired Combustion Turbine · 229.6 MW generator nameplate

    Location: EIA-reported plant coordinate; not a surveyed boundary

    Operator: City of San Antonio - (TX). EIA sector: Electric Utility. Includes generators reported operating in EIA-860 M; standby, out-of-service, retired and storage units excluded.

    Evidence date: EIA August 2026 snapshot, released September 24, 2026; reviewed October 20, 2026

    EIA-860M August 2026 inventory (released September 24, 2026)EIA inventory methodology
  • O W Sommers

    Operating · Bexar County

    Operating (EIA August 2026); (OP) Operating

    Natural gas · Natural Gas Steam Turbine · 892 MW generator nameplate

    Location: EIA-reported plant coordinate; not a surveyed boundary

    Operator: City of San Antonio - (TX). EIA sector: Electric Utility. Includes generators reported operating in EIA-860 M; standby, out-of-service, retired and storage units excluded.

    Evidence date: EIA August 2026 snapshot, released September 24, 2026; reviewed October 20, 2026

    EIA-860M August 2026 inventory (released September 24, 2026)EIA inventory methodology
  • OCI Alamo Solar I Hybrid

    Operating · Bexar County

    Operating (EIA August 2026); (OP) Operating

    Solar · Solar Photovoltaic · 40.7 MW generator nameplate

    Location: EIA-reported plant coordinate; not a surveyed boundary

    Operator: OCI Energy LLC. EIA sector: IPP Non-CHP. Includes generators reported operating in EIA-860 M; standby, out-of-service, retired and storage units excluded.

    Evidence date: EIA August 2026 snapshot, released September 24, 2026; reviewed October 20, 2026

    EIA-860M August 2026 inventory (released September 24, 2026)EIA inventory methodology
  • SunE CPS1 LLC

    Operating · Bexar County

    Operating (EIA August 2026); (OP) Operating

    Solar · Solar Photovoltaic · 10 MW generator nameplate

    Location: EIA-reported plant coordinate; not a surveyed boundary

    Operator: REC Solar. EIA sector: IPP Non-CHP. Includes generators reported operating in EIA-860 M; standby, out-of-service, retired and storage units excluded.

    Evidence date: EIA August 2026 snapshot, released September 24, 2026; reviewed October 20, 2026

    EIA-860M August 2026 inventory (released September 24, 2026)EIA inventory methodology
  • SunE CPS2 LLC

    Operating · Bexar County

    Operating (EIA August 2026); (OP) Operating

    Solar · Solar Photovoltaic · 10 MW generator nameplate

    Location: EIA-reported plant coordinate; not a surveyed boundary

    Operator: REC Solar. EIA sector: IPP Non-CHP. Includes generators reported operating in EIA-860 M; standby, out-of-service, retired and storage units excluded.

    Evidence date: EIA August 2026 snapshot, released September 24, 2026; reviewed October 20, 2026

    EIA-860M August 2026 inventory (released September 24, 2026)EIA inventory methodology
  • SunE CPS3 LLC

    Operating · Bexar County

    Operating (EIA August 2026); (OP) Operating

    Solar · Solar Photovoltaic · 10.6 MW generator nameplate

    Location: EIA-reported plant coordinate; not a surveyed boundary

    Operator: REC Solar. EIA sector: IPP Non-CHP. Includes generators reported operating in EIA-860 M; standby, out-of-service, retired and storage units excluded.

    Evidence date: EIA August 2026 snapshot, released September 24, 2026; reviewed October 20, 2026

    EIA-860M August 2026 inventory (released September 24, 2026)EIA inventory methodology
  • V H Braunig

    Operating · Bexar County

    Operating (EIA August 2026); (OP) Operating

    Natural gas · Natural Gas Fired Combustion Turbine · 244 MW generator nameplate

    Location: EIA-reported plant coordinate; not a surveyed boundary

    Operator: City of San Antonio - (TX). EIA sector: Electric Utility. Includes generators reported operating in EIA-860 M; standby, out-of-service, retired and storage units excluded.

    Evidence date: EIA August 2026 snapshot, released September 24, 2026; reviewed October 20, 2026

    EIA-860M August 2026 inventory (released September 24, 2026)EIA inventory methodology
  • Granite Shoals

    Operating · Burnet County

    Operating (EIA August 2026); (OP) Operating

    Hydroelectric · Conventional Hydroelectric · 54 MW generator nameplate

    Location: EIA-reported plant coordinate; not a surveyed boundary

    Operator: Lower Colorado River Authority. EIA sector: Electric Utility. Includes generators reported operating in EIA-860 M; standby, out-of-service, retired and storage units excluded.

    Evidence date: EIA August 2026 snapshot, released September 24, 2026; reviewed October 20, 2026

    EIA-860M August 2026 inventory (released September 24, 2026)EIA inventory methodology
  • Inks

    Operating · Burnet County

    Operating (EIA August 2026); (OP) Operating

    Hydroelectric · Conventional Hydroelectric · 15 MW generator nameplate

    Location: EIA-reported plant coordinate; not a surveyed boundary

    Operator: Lower Colorado River Authority. EIA sector: Electric Utility. Includes generators reported operating in EIA-860 M; standby, out-of-service, retired and storage units excluded.

    Evidence date: EIA August 2026 snapshot, released September 24, 2026; reviewed October 20, 2026

    EIA-860M August 2026 inventory (released September 24, 2026)EIA inventory methodology
  • Marble Falls

    Operating · Burnet County

    Operating (EIA August 2026); (OP) Operating

    Hydroelectric · Conventional Hydroelectric · 39.6 MW generator nameplate

    Location: EIA-reported plant coordinate; not a surveyed boundary

    Operator: Lower Colorado River Authority. EIA sector: Electric Utility. Includes generators reported operating in EIA-860 M; standby, out-of-service, retired and storage units excluded.

    Evidence date: EIA August 2026 snapshot, released September 24, 2026; reviewed October 20, 2026

    EIA-860M August 2026 inventory (released September 24, 2026)EIA inventory methodology
  • RedSun PV and BESS

    Planned / permitting / discussion · Burnet County

    Planned (EIA August 2026); (L) Regulatory approvals pending. Not under construction

    Solar · Solar Photovoltaic · 84 MW generator nameplate

    Location: EIA-reported plant coordinate; not a surveyed boundary

    Operator: Gransolar Texas Twenty Two LLC. EIA sector: IPP Non-CHP. Developer schedule/status reported to EIA. Planned operation dates and permit activity do not establish construction or commercial operation.

    Evidence date: EIA August 2026 snapshot, released September 24, 2026; reviewed October 20, 2026

    EIA-860M August 2026 inventory (released September 24, 2026)EIA inventory methodology
  • Caldwell Power Generation Plant / Edged campus filing

    Planned / permitting / discussion · Caldwell County

    Permit-stage generation / operating role unconfirmed; Permit-stage generation / operating role unconfirmed

    Generation technology unconfirmed · Generation equipment / fuel unconfirmed · Capacity unreported / not verified

    Location: Approximate location near filed campus address; generation site not separately verified

    Operator: Edged Energy-associated campus / Caldwell Power Generation Plant. Previously researched TCEQ standard-permit filing 185697. Public Citizen/FracTracker October 2026 record says engineer initial review completedOctober 14. Capacity, fuel/equipment and whether intended for continuous, bridge or backup duty have not been verified from the technical application. Included as a flagged generation filing, not a confirmed utility-scale operating plant. Approximate Edged campus address 11255 Highway 142,Maxwell; separate from nearby operating LCRA Timmerman.

    Evidence date: Reviewed October 20, 2026

    TCEQ Central Registry (search registration 185697)Public Citizen/FracTracker permit activity summaryTDLR Edged campus address TABS2026019322
  • Timmerman Power Plant

    Operating · Caldwell County

    Operating (EIA August 2026); (OP) Operating

    Natural gas · Natural Gas Internal Combustion Engine · 368 MW generator nameplate

    Location: EIA-reported plant coordinate; not a surveyed boundary

    Operator: Lower Colorado River Authority. EIA sector: Electric Utility. Includes generators reported operating in EIA-860 M; standby, out-of-service, retired and storage units excluded. LCRA confirms fully online; first unit August 2025, second April 2026; LCRA advertised output approximately 380 MW compared with EIA 368 MW nameplate.

    Evidence date: EIA August 2026 snapshot, released September 24, 2026; reviewed October 20, 2026

    EIA-860M August 2026 inventory (released September 24, 2026)EIA inventory methodologyLCRA Timmerman fully online380MW
  • Tract Caldwell Valley planned onsite generation

    Planned / permitting / discussion · Caldwell County

    Planned / generator capacity undisclosed; Planned / generator capacity undisclosed

    Natural gas · Natural gas generation · Capacity unreported / not verified

    Location: Approximate Uhland/Caldwell Valley area; not verified parcel or generator site

    Operator: Tract. Tract January 13, 2026 release says it initiated plans for onsite generation that will become grid-connected. More than 4 GW is prospective data-center capacity, not disclosed powerplant capacity;1.6 GW is substation scale, not generation. Area marker near Uhland; parcel position not verified.

    Evidence date: Reviewed October 20, 2026

    Tract January 13, 2026 campus expansion and onsite-generation announcement
  • Rock Island Generation Project

    Planned / permitting / discussion · Colorado County

    Planned (EIA August 2026); (L) Regulatory approvals pending. Not under construction

    Natural gas · Natural Gas Internal Combustion Engine · 121.8 MW generator nameplate

    Location: EIA-reported plant coordinate; not a surveyed boundary

    Operator: Kerrville Public Utility Board Public Facility Corp. EIA sector: Electric Utility. Developer schedule/status reported to EIA. Planned operation dates and permit activity do not establish construction or commercial operation.

    Evidence date: EIA August 2026 snapshot, released September 24, 2026; reviewed October 20, 2026

    EIA-860M August 2026 inventory (released September 24, 2026)EIA inventory methodology
  • Sky Global Power One

    Operating · Colorado County

    Operating (EIA August 2026); (OP) Operating

    Natural gas · Natural Gas Internal Combustion Engine · 51 MW generator nameplate

    Location: EIA-reported plant coordinate; not a surveyed boundary

    Operator: Sky Global Power One Pledgor, LLC. EIA sector: IPP Non-CHP. Includes generators reported operating in EIA-860 M; standby, out-of-service, retired and storage units excluded.

    Evidence date: EIA August 2026 snapshot, released September 24, 2026; reviewed October 20, 2026

    EIA-860M August 2026 inventory (released September 24, 2026)EIA inventory methodology
  • Bynum Solar Project

    Operating · Coryell County

    Operating (EIA August 2026); (OP) Operating

    Solar · Solar Photovoltaic · 56 MW generator nameplate

    Location: EIA-reported plant coordinate; not a surveyed boundary

    Operator: Bynum Solar Project LLC (RE). EIA sector: IPP Non-CHP. Includes generators reported operating in EIA-860 M; standby, out-of-service, retired and storage units excluded.

    Evidence date: EIA August 2026 snapshot, released September 24, 2026; reviewed October 20, 2026

    EIA-860M August 2026 inventory (released September 24, 2026)EIA inventory methodology
  • BPL Crown Solar LLC

    Operating · Falls County

    Operating (EIA August 2026); (OP) Operating

    Solar · Solar Photovoltaic · 100 MW generator nameplate

    Location: EIA-reported plant coordinate; not a surveyed boundary

    Operator: BPL Crown Solar LLC. EIA sector: IPP Non-CHP. Includes generators reported operating in EIA-860 M; standby, out-of-service, retired and storage units excluded.

    Evidence date: EIA August 2026 snapshot, released September 24, 2026; reviewed October 20, 2026

    EIA-860M August 2026 inventory (released September 24, 2026)EIA inventory methodology
  • BPL Sol Solar LLC

    Operating · Falls County

    Operating (EIA August 2026); (OP) Operating

    Solar · Solar Photovoltaic · 100 MW generator nameplate

    Location: EIA-reported plant coordinate; not a surveyed boundary

    Operator: BPL Sol Solar LLC. EIA sector: IPP Non-CHP. Includes generators reported operating in EIA-860 M; standby, out-of-service, retired and storage units excluded.

    Evidence date: EIA August 2026 snapshot, released September 24, 2026; reviewed October 20, 2026

    EIA-860M August 2026 inventory (released September 24, 2026)EIA inventory methodology
  • Blevins Solar & Storage

    Operating · Falls County

    Operating (EIA August 2026); (OP) Operating

    Solar · Solar Photovoltaic · 270 MW generator nameplate

    Location: EIA-reported plant coordinate; not a surveyed boundary

    Operator: Geronimo Power. EIA sector: IPP Non-CHP. Includes generators reported operating in EIA-860 M; standby, out-of-service, retired and storage units excluded.

    Evidence date: EIA August 2026 snapshot, released September 24, 2026; reviewed October 20, 2026

    EIA-860M August 2026 inventory (released September 24, 2026)EIA inventory methodology
  • Roseland Solar Project, LLC

    Operating · Falls County

    Operating (operator sustainability report); Enel 2023 Year in Review confirms Roseland came online in 2023; EIA August 2026 entry lags this evidence.

    Solar · Solar Photovoltaic · 500 MW generator nameplate

    Location: EIA-reported plant coordinate; not a surveyed boundary

    Operator: Enel Green Power Roseland Solar, LLC. EIA sector: IPP Non-CHP. Developer schedule/status reported to EIA. Planned operation dates and permit activity do not establish construction or commercial operation. Operator cites 640 MWdc; EIA 500 MW generator nameplate is a different rating. Paired storage is excluded.

    Evidence date: EIA August 2026 snapshot, released September 24, 2026; reviewed October 20, 2026

    EIA-860M August 2026 inventory (released September 24, 2026)EIA inventory methodologyEnel 2023 Sustainability Year in Review, page 1
  • True North Solar, LLC

    Operating · Falls County

    Operating (EIA August 2026); (OP) Operating

    Solar · Solar Photovoltaic · 238.8 MW generator nameplate

    Location: EIA-reported plant coordinate; not a surveyed boundary

    Operator: Avangrid Power LLC. EIA sector: IPP Non-CHP. Includes generators reported operating in EIA-860 M; standby, out-of-service, retired and storage units excluded.

    Evidence date: EIA August 2026 snapshot, released September 24, 2026; reviewed October 20, 2026

    EIA-860M August 2026 inventory (released September 24, 2026)EIA inventory methodology
  • 7V Solar Ranch

    Operating · Fayette County

    Operating (EIA August 2026); (OP) Operating

    Solar · Solar Photovoltaic · 240 MW generator nameplate

    Location: EIA-reported plant coordinate; not a surveyed boundary

    Operator: 7 V Solar Ranch, LLC. EIA sector: IPP Non-CHP. Includes generators reported operating in EIA-860 M; standby, out-of-service, retired and storage units excluded.

    Evidence date: EIA August 2026 snapshot, released September 24, 2026; reviewed October 20, 2026

    EIA-860M August 2026 inventory (released September 24, 2026)EIA inventory methodology
  • Fayette Power Project

    Operating · Fayette County

    Operating (EIA August 2026); (OP) Operating

    Coal · Conventional Steam Coal · 1,690 MW generator nameplate

    Location: EIA-reported plant coordinate; not a surveyed boundary

    Operator: Lower Colorado River Authority. EIA sector: Electric Utility. Includes generators reported operating in EIA-860 M; standby, out-of-service, retired and storage units excluded.

    Evidence date: EIA August 2026 snapshot, released September 24, 2026; reviewed October 20, 2026

    EIA-860M August 2026 inventory (released September 24, 2026)EIA inventory methodology
  • Winchester Power Park

    Operating · Fayette County

    Operating (EIA August 2026); (OP) Operating

    Natural gas · Natural Gas Fired Combustion Turbine · 242 MW generator nameplate

    Location: EIA-reported plant coordinate; not a surveyed boundary

    Operator: Lower Colorado River Authority. EIA sector: Electric Utility. Includes generators reported operating in EIA-860 M; standby, out-of-service, retired and storage units excluded.

    Evidence date: EIA August 2026 snapshot, released September 24, 2026; reviewed October 20, 2026

    EIA-860M August 2026 inventory (released September 24, 2026)EIA inventory methodology
  • Guadalupe Generating Station

    Operating · Guadalupe County

    Operating (EIA August 2026); (OP) Operating

    Natural gas · Natural Gas Fired Combined Cycle · 1,088.2 MW generator nameplate

    Location: EIA-reported plant coordinate; not a surveyed boundary

    Operator: Guadalupe Power Partners LP. EIA sector: IPP Non-CHP. Includes generators reported operating in EIA-860 M; standby, out-of-service, retired and storage units excluded.

    Evidence date: EIA August 2026 snapshot, released September 24, 2026; reviewed October 20, 2026

    EIA-860M August 2026 inventory (released September 24, 2026)EIA inventory methodology
  • Rio Nogales Power Project

    Operating · Guadalupe County

    Operating (EIA August 2026); (OP) Operating

    Natural gas · Natural Gas Fired Combined Cycle · 1,108 MW generator nameplate

    Location: EIA-reported plant coordinate; not a surveyed boundary

    Operator: City of San Antonio - (TX). EIA sector: Electric Utility. Includes generators reported operating in EIA-860 M; standby, out-of-service, retired and storage units excluded.

    Evidence date: EIA August 2026 snapshot, released September 24, 2026; reviewed October 20, 2026

    EIA-860M August 2026 inventory (released September 24, 2026)EIA inventory methodology
  • Grizzly Ridge Solar

    Operating · Hamilton County

    Operating (EIA August 2026); (OP) Operating

    Solar · Solar Photovoltaic · 100 MW generator nameplate

    Location: EIA-reported plant coordinate; not a surveyed boundary

    Operator: Grizzly Ridge Solar LLC. EIA sector: IPP Non-CHP. Includes generators reported operating in EIA-860 M; standby, out-of-service, retired and storage units excluded.

    Evidence date: EIA August 2026 snapshot, released September 24, 2026; reviewed October 20, 2026

    EIA-860M August 2026 inventory (released September 24, 2026)EIA inventory methodology
  • Hays Energy Project

    Operating · Hays County

    Operating (EIA August 2026); (OP) Operating

    Natural gas · Natural Gas Fired Combined Cycle · 989 MW generator nameplate

    Location: EIA-reported plant coordinate; not a surveyed boundary

    Operator: Hays Energy, LLC. EIA sector: IPP Non-CHP. Includes generators reported operating in EIA-860 M; standby, out-of-service, retired and storage units excluded.

    Evidence date: EIA August 2026 snapshot, released September 24, 2026; reviewed October 20, 2026

    EIA-860M August 2026 inventory (released September 24, 2026)EIA inventory methodology
  • CloudBurst San Marcos proposed onsite power

    Planned / permitting / discussion · Hays / Guadalupe County

    Planned onsite generation / plant construction unconfirmed; Planned onsite generation / plant construction unconfirmed

    Natural gas · Natural gas generation · Up to 1,200 MW proposed

    Location: Address geocode at 2955 Francis Harris Lane; approximate campus access, not generator pads

    Operator: CloudBurst Data Centers. Energy Transfer February 10, 2025 gas-supply agreement sufficient for up to 1.2 GW direct/behind-the-meter generation, subject to customer final investment decision. Data-center campus groundbreaking does not establish generation-equipment construction or operation. Gas contract scale is not proof of installed plant capacity. Campus access address 2955 Francis Harris Lane geocoded; generator pads unconfirmed.

    Evidence date: Reviewed October 20, 2026

    Energy Transfer gas supply agreement February 10, 2025
  • Sandow Lakes Energy Station

    Planned / permitting / discussion · Lee County

    Planned (EIA August 2026); (P) Planned for installation, but regulatory approvals not initiated

    Natural gas · Natural Gas Fired Combined Cycle · 1,290 MW generator nameplate

    Location: EIA-reported plant coordinate; not a surveyed boundary

    Operator: SL Energy Power Plant I, LLC. EIA sector: IPP Non-CHP. Developer schedule/status reported to EIA. Planned operation dates and permit activity do not establish construction or commercial operation. Developer advertises approximately 1,200 MW net; EIA lists 1,290 MW nameplate. These use different capacity measures. New Lee County gas project is separate from retired Milam County Sandow coal plant and not established as dedicated data-center generation.

    Evidence date: EIA August 2026 snapshot, released September 24, 2026; reviewed October 20, 2026

    EIA-860M August 2026 inventory (released September 24, 2026)EIA inventory methodologySandow Lakes Energy project announcement
  • Buchanan Dam (TX)

    Operating · Llano County

    Operating (EIA August 2026); (OP) Operating

    Hydroelectric · Conventional Hydroelectric · 54.9 MW generator nameplate

    Location: EIA-reported plant coordinate; not a surveyed boundary

    Operator: Lower Colorado River Authority. EIA sector: Electric Utility. Includes generators reported operating in EIA-860 M; standby, out-of-service, retired and storage units excluded.

    Evidence date: EIA August 2026 snapshot, released September 24, 2026; reviewed October 20, 2026

    EIA-860M August 2026 inventory (released September 24, 2026)EIA inventory methodology
  • Thomas C Ferguson

    Operating · Llano County

    Operating (EIA August 2026); (OP) Operating

    Natural gas · Natural Gas Fired Combined Cycle · 574.6 MW generator nameplate

    Location: EIA-reported plant coordinate; not a surveyed boundary

    Operator: Lower Colorado River Authority. EIA sector: Electric Utility. Includes generators reported operating in EIA-860 M; standby, out-of-service, retired and storage units excluded.

    Evidence date: EIA August 2026 snapshot, released September 24, 2026; reviewed October 20, 2026

    EIA-860M August 2026 inventory (released September 24, 2026)EIA inventory methodology
  • Albatross Solar, LLC

    Planned / permitting / discussion · McLennan County

    Planned (EIA August 2026); (P) Planned for installation, but regulatory approvals not initiated

    Solar · Solar Photovoltaic · 101 MW generator nameplate

    Location: EIA-reported plant coordinate; not a surveyed boundary

    Operator: Sunraycer Assets I LLC. EIA sector: IPP Non-CHP. Developer schedule/status reported to EIA. Planned operation dates and permit activity do not establish construction or commercial operation.

    Evidence date: EIA August 2026 snapshot, released September 24, 2026; reviewed October 20, 2026

    EIA-860M August 2026 inventory (released September 24, 2026)EIA inventory methodology
  • Braswell Solar

    Planned / permitting / discussion · McLennan County

    Planned (EIA August 2026); (L) Regulatory approvals pending. Not under construction

    Solar · Solar Photovoltaic · 44.2 MW generator nameplate

    Location: EIA-reported plant coordinate; not a surveyed boundary

    Operator: Gransolar Texas Nine LLC. EIA sector: IPP Non-CHP. Developer schedule/status reported to EIA. Planned operation dates and permit activity do not establish construction or commercial operation.

    Evidence date: EIA August 2026 snapshot, released September 24, 2026; reviewed October 20, 2026

    EIA-860M August 2026 inventory (released September 24, 2026)EIA inventory methodology
  • Copperhead Solar, LLC

    Operating · McLennan County

    Operating (EIA August 2026); (OP) Operating

    Solar · Solar Photovoltaic · 150 MW generator nameplate

    Location: EIA-reported plant coordinate; not a surveyed boundary

    Operator: Geronimo Power. EIA sector: IPP Non-CHP. Includes generators reported operating in EIA-860 M; standby, out-of-service, retired and storage units excluded.

    Evidence date: EIA August 2026 snapshot, released September 24, 2026; reviewed October 20, 2026

    EIA-860M August 2026 inventory (released September 24, 2026)EIA inventory methodology
  • Eddy II

    Operating · McLennan County

    Operating (EIA August 2026); (OP) Operating

    Solar · Solar Photovoltaic · 10 MW generator nameplate

    Location: EIA-reported plant coordinate; not a surveyed boundary

    Operator: Cypress Creek Renewables. EIA sector: IPP Non-CHP. Includes generators reported operating in EIA-860 M; standby, out-of-service, retired and storage units excluded.

    Evidence date: EIA August 2026 snapshot, released September 24, 2026; reviewed October 20, 2026

    EIA-860M August 2026 inventory (released September 24, 2026)EIA inventory methodology
  • GPI WACO Power

    Under construction · McLennan County

    Construction / commissioning (EIA August 2026); (U) Under construction, less than or equal to 50 percent complete

    Natural gas · Natural Gas Fired Combustion Turbine · 43.4 MW generator nameplate

    Location: EIA-reported plant coordinate; not a surveyed boundary

    Operator: Graphic Packaging International - WACO. EIA sector: Industrial Non-CHP. Developer schedule/status reported to EIA. Planned operation dates and permit activity do not establish construction or commercial operation. Onsite/captive commercial or industrial generation; included under EIA’s plant-size threshold of at least 1 MW.

    Evidence date: EIA August 2026 snapshot, released September 24, 2026; reviewed October 20, 2026

    EIA-860M August 2026 inventory (released September 24, 2026)EIA inventory methodology
  • Pepper Solar Farm

    Planned / permitting / discussion · McLennan County

    Planned (EIA August 2026); (P) Planned for installation, but regulatory approvals not initiated

    Solar · Solar Photovoltaic · 120 MW generator nameplate

    Location: EIA-reported plant coordinate; not a surveyed boundary

    Operator: Pepper Solar Farm, LLC. EIA sector: IPP Non-CHP. Developer schedule/status reported to EIA. Planned operation dates and permit activity do not establish construction or commercial operation.

    Evidence date: EIA August 2026 snapshot, released September 24, 2026; reviewed October 20, 2026

    EIA-860M August 2026 inventory (released September 24, 2026)EIA inventory methodology
  • Tokio Solar

    Planned / permitting / discussion · McLennan County

    Planned (EIA August 2026); (P) Planned for installation, but regulatory approvals not initiated

    Solar · Solar Photovoltaic · 170.4 MW generator nameplate

    Location: EIA-reported plant coordinate; not a surveyed boundary

    Operator: Gransolar Texas Eight, LLC. EIA sector: IPP Non-CHP. Developer schedule/status reported to EIA. Planned operation dates and permit activity do not establish construction or commercial operation.

    Evidence date: EIA August 2026 snapshot, released September 24, 2026; reviewed October 20, 2026

    EIA-860M August 2026 inventory (released September 24, 2026)EIA inventory methodology
  • BT Jungmann

    Operating · Milam County

    Operating (EIA August 2026); (OP) Operating

    Solar · Solar Photovoltaic · 40 MW generator nameplate

    Location: EIA-reported plant coordinate; not a surveyed boundary

    Operator: BT Jungmann, LLC. EIA sector: IPP Non-CHP. Includes generators reported operating in EIA-860 M; standby, out-of-service, retired and storage units excluded.

    Evidence date: EIA August 2026 snapshot, released September 24, 2026; reviewed October 20, 2026

    EIA-860M August 2026 inventory (released September 24, 2026)EIA inventory methodology
  • Cattlemen Solar II

    Operating · Milam County

    Operating (developer confirmed); Developer states Cattlemen I/II operating; EIA August 2026 planned/commissioning entry lags developer evidence.

    Solar · Solar Photovoltaic · 200 MW generator nameplate

    Location: EIA-reported plant coordinate; not a surveyed boundary

    Operator: Cattlemen Solar Park II LLC. EIA sector: IPP Non-CHP. Developer schedule/status reported to EIA. Planned operation dates and permit activity do not establish construction or commercial operation. Developer lists the two-phase park as 390 MW (240 MW I +150 MW II); EIA nameplate for II is 200 MW, so capacity definitions differ.

    Evidence date: EIA August 2026 snapshot, released September 24, 2026; reviewed October 20, 2026

    EIA-860M August 2026 inventory (released September 24, 2026)EIA inventory methodologyEDP Cattlemen Solar Park: two phases, installed 390 MWEDP confirms Cattlemen II online (February10 2025)
  • Cattlemen Solar Park

    Operating · Milam County

    Operating (developer confirmed); Developer states Cattlemen I/II operating; EIA August 2026 planned/commissioning entry lags developer evidence.

    Solar · Solar Photovoltaic · 240 MW generator nameplate

    Location: EIA-reported plant coordinate; not a surveyed boundary

    Operator: Cattlemen Solar Park LLC. EIA sector: IPP Non-CHP. Developer schedule/status reported to EIA. Planned operation dates and permit activity do not establish construction or commercial operation. Developer lists the two-phase park as 390 MW (240 MW I +150 MW II); EIA nameplate for II is 200 MW, so capacity definitions differ.

    Evidence date: EIA August 2026 snapshot, released September 24, 2026; reviewed October 20, 2026

    EIA-860M August 2026 inventory (released September 24, 2026)EIA inventory methodologyEDP Cattlemen Solar Park: two phases, installed 390 MWEDP confirms Cattlemen II online (February10 2025)
  • Gransolar Texas One, LLC

    Operating · Milam County

    Operating (EIA August 2026); (OP) Operating

    Solar · Solar Photovoltaic · 50 MW generator nameplate

    Location: EIA-reported plant coordinate; not a surveyed boundary

    Operator: Gransolar Texas One, LLC. EIA sector: IPP Non-CHP. Includes generators reported operating in EIA-860 M; standby, out-of-service, retired and storage units excluded.

    Evidence date: EIA August 2026 snapshot, released September 24, 2026; reviewed October 20, 2026

    EIA-860M August 2026 inventory (released September 24, 2026)EIA inventory methodology
  • Orion I Solar Project

    Operating · Milam County

    Operating (EIA August 2026); (OP) Operating

    Solar · Solar Photovoltaic · 200 MW generator nameplate

    Location: EIA-reported plant coordinate; not a surveyed boundary

    Operator: Ben Milam Solar 1 LLC. EIA sector: IPP Non-CHP. Includes generators reported operating in EIA-860 M; standby, out-of-service, retired and storage units excluded.

    Evidence date: EIA August 2026 snapshot, released September 24, 2026; reviewed October 20, 2026

    EIA-860M August 2026 inventory (released September 24, 2026)EIA inventory methodology
  • Orion II Solar Project

    Operating · Milam County

    Operating (EIA August 2026); (OP) Operating

    Solar · Solar Photovoltaic · 250 MW generator nameplate

    Location: EIA-reported plant coordinate; not a surveyed boundary

    Operator: Ben Milam Solar 2 LLC. EIA sector: IPP Non-CHP. Includes generators reported operating in EIA-860 M; standby, out-of-service, retired and storage units excluded.

    Evidence date: EIA August 2026 snapshot, released September 24, 2026; reviewed October 20, 2026

    EIA-860M August 2026 inventory (released September 24, 2026)EIA inventory methodology
  • Orion III Solar Project

    Operating · Milam County

    Operating (EIA August 2026); (OP) Operating

    Solar · Solar Photovoltaic · 250 MW generator nameplate

    Location: EIA-reported plant coordinate; not a surveyed boundary

    Operator: Ben Milam Solar 3 LLC. EIA sector: IPP Non-CHP. Includes generators reported operating in EIA-860 M; standby, out-of-service, retired and storage units excluded.

    Evidence date: EIA August 2026 snapshot, released September 24, 2026; reviewed October 20, 2026

    EIA-860M August 2026 inventory (released September 24, 2026)EIA inventory methodology
  • Stoneridge Solar, LLC

    Operating · Milam County

    Operating (EIA August 2026); (OP) Operating

    Solar · Solar Photovoltaic · 200 MW generator nameplate

    Location: EIA-reported plant coordinate; not a surveyed boundary

    Operator: RWE Clean Energy. EIA sector: IPP Non-CHP. Includes generators reported operating in EIA-860 M; standby, out-of-service, retired and storage units excluded.

    Evidence date: EIA August 2026 snapshot, released September 24, 2026; reviewed October 20, 2026

    EIA-860M August 2026 inventory (released September 24, 2026)EIA inventory methodology
  • Sypert Branch Solar

    Under construction · Milam County

    Construction / commissioning (EIA August 2026); (U) Under construction, less than or equal to 50 percent complete

    Solar · Solar Photovoltaic · 293.9 MW generator nameplate

    Location: EIA-reported plant coordinate; not a surveyed boundary

    Operator: Sypert Branch Solar LLC. EIA sector: IPP Non-CHP. Developer schedule/status reported to EIA. Planned operation dates and permit activity do not establish construction or commercial operation.

    Evidence date: EIA August 2026 snapshot, released September 24, 2026; reviewed October 20, 2026

    EIA-860M August 2026 inventory (released September 24, 2026)EIA inventory methodology
  • Yaupon Solar Project (Hybrid)

    Under construction · Milam County

    Construction / commissioning (EIA August 2026); (TS) Construction complete, but not yet in commercial operation

    Solar · Solar Photovoltaic · 200 MW generator nameplate

    Location: EIA-reported plant coordinate; not a surveyed boundary

    Operator: Yaupon Solar, LLC. EIA sector: IPP Non-CHP. Developer schedule/status reported to EIA. Planned operation dates and permit activity do not establish construction or commercial operation.

    Evidence date: EIA August 2026 snapshot, released September 24, 2026; reviewed October 20, 2026

    EIA-860M August 2026 inventory (released September 24, 2026)EIA inventory methodology
  • Castle Gap Wind

    Operating · Mills County

    Operating (EIA August 2026); (OP) Operating

    Wind · Onshore Wind Turbine · 196.8 MW generator nameplate

    Location: EIA-reported plant coordinate; not a surveyed boundary

    Operator: Castle Gap Wind Power, LLC. EIA sector: IPP Non-CHP. Includes generators reported operating in EIA-860 M; standby, out-of-service, retired and storage units excluded.

    Evidence date: EIA August 2026 snapshot, released September 24, 2026; reviewed October 20, 2026

    EIA-860M August 2026 inventory (released September 24, 2026)EIA inventory methodology
  • Flat Top Wind I

    Operating · Mills County

    Operating (EIA August 2026); (OP) Operating

    Wind · Onshore Wind Turbine · 200 MW generator nameplate

    Location: EIA-reported plant coordinate; not a surveyed boundary

    Operator: BHE Renewables, LLC. EIA sector: IPP Non-CHP. Includes generators reported operating in EIA-860 M; standby, out-of-service, retired and storage units excluded.

    Evidence date: EIA August 2026 snapshot, released September 24, 2026; reviewed October 20, 2026

    EIA-860M August 2026 inventory (released September 24, 2026)EIA inventory methodology
  • Goldthwaite Wind Energy Facility

    Operating · Mills County

    Operating (EIA August 2026); (OP) Operating

    Wind · Onshore Wind Turbine · 150 MW generator nameplate

    Location: EIA-reported plant coordinate; not a surveyed boundary

    Operator: Invenergy Services LLC. EIA sector: IPP Non-CHP. Includes generators reported operating in EIA-860 M; standby, out-of-service, retired and storage units excluded.

    Evidence date: EIA August 2026 snapshot, released September 24, 2026; reviewed October 20, 2026

    EIA-860M August 2026 inventory (released September 24, 2026)EIA inventory methodology
  • Priddy Wind Project

    Operating · Mills County

    Operating (EIA August 2026); (OP) Operating

    Wind · Onshore Wind Turbine · 302.4 MW generator nameplate

    Location: EIA-reported plant coordinate; not a surveyed boundary

    Operator: Engie North America. EIA sector: IPP Non-CHP. Includes generators reported operating in EIA-860 M; standby, out-of-service, retired and storage units excluded.

    Evidence date: EIA August 2026 snapshot, released September 24, 2026; reviewed October 20, 2026

    EIA-860M August 2026 inventory (released September 24, 2026)EIA inventory methodology
  • Austin

    Operating · Travis County

    Operating (EIA August 2026); (OP) Operating

    Hydroelectric · Conventional Hydroelectric · 18 MW generator nameplate

    Location: EIA-reported plant coordinate; not a surveyed boundary

    Operator: Lower Colorado River Authority. EIA sector: Electric Utility. Includes generators reported operating in EIA-860 M; standby, out-of-service, retired and storage units excluded.

    Evidence date: EIA August 2026 snapshot, released September 24, 2026; reviewed October 20, 2026

    EIA-860M August 2026 inventory (released September 24, 2026)EIA inventory methodology
  • Austin Energy new400 MW gas peaker program

    Planned / permitting / discussion · Travis County

    Planned / contracting authorized; site undisclosed; Planned / contracting authorized; site undisclosed

    Natural gas · Natural gas generation · Up to 400 MW proposed

    Location: REGIONAL PLACEHOLDER ONLY: Austin city-center point; site(s) not disclosed

    Operator: Austin Energy. Austin City Council May 21, 2026 approval allows contracting 400 MW high-efficiency gas peaker units. Exact plant location(s) not disclosed in the official release; this marker represents the Austin area only. It is not a confirmed site, downtown project or construction location.299 MW wind procurement announced alongside it is a separate resource and not geolocated here;100 MW batteries are storage rather than generation.

    Evidence date: Reviewed October 20, 2026

    Austin Energy May 21, 2026 official announcement
  • Decker Creek

    Operating · Travis County

    Operating (EIA August 2026); (OP) Operating

    Natural gas · Natural Gas Fired Combustion Turbine · 206 MW generator nameplate

    Location: EIA-reported plant coordinate; not a surveyed boundary

    Operator: Austin Energy. EIA sector: Electric Utility. Includes generators reported operating in EIA-860 M; standby, out-of-service, retired and storage units excluded.

    Evidence date: EIA August 2026 snapshot, released September 24, 2026; reviewed October 20, 2026

    EIA-860M August 2026 inventory (released September 24, 2026)EIA inventory methodology
  • East Blackland Solar Project 1

    Operating · Travis County

    Operating (EIA August 2026); (OP) Operating

    Solar · Solar Photovoltaic · 144 MW generator nameplate

    Location: EIA-reported plant coordinate; not a surveyed boundary

    Operator: Deriva Energy. EIA sector: IPP Non-CHP. Includes generators reported operating in EIA-860 M; standby, out-of-service, retired and storage units excluded.

    Evidence date: EIA August 2026 snapshot, released September 24, 2026; reviewed October 20, 2026

    EIA-860M August 2026 inventory (released September 24, 2026)EIA inventory methodology
  • Hal C Weaver Power Plant

    Operating · Travis County

    Operating (EIA August 2026); (OP) Operating

    Natural gas · Natural Gas Fired Combined Cycle · 104.5 MW generator nameplate

    Location: EIA-reported plant coordinate; not a surveyed boundary

    Operator: University of Texas at Austin. EIA sector: Commercial CHP. Includes generators reported operating in EIA-860 M; standby, out-of-service, retired and storage units excluded. Onsite/captive commercial or industrial generation; included under EIA’s plant-size threshold of at least 1 MW.

    Evidence date: EIA August 2026 snapshot, released September 24, 2026; reviewed October 20, 2026

    EIA-860M August 2026 inventory (released September 24, 2026)EIA inventory methodology
  • Marshall Ford

    Operating · Travis County

    Operating (EIA August 2026); (OP) Operating

    Hydroelectric · Conventional Hydroelectric · 108 MW generator nameplate

    Location: EIA-reported plant coordinate; not a surveyed boundary

    Operator: Lower Colorado River Authority. EIA sector: Electric Utility. Includes generators reported operating in EIA-860 M; standby, out-of-service, retired and storage units excluded.

    Evidence date: EIA August 2026 snapshot, released September 24, 2026; reviewed October 20, 2026

    EIA-860M August 2026 inventory (released September 24, 2026)EIA inventory methodology
  • Sand Hill

    Operating · Travis County

    Operating (EIA August 2026); (OP) Operating

    Natural gas · Natural Gas Fired Combined Cycle; Natural Gas Fired Combustion Turbine · 696.4 MW generator nameplate

    Location: EIA-reported plant coordinate; not a surveyed boundary

    Operator: Austin Energy. EIA sector: Electric Utility. Includes generators reported operating in EIA-860 M; standby, out-of-service, retired and storage units excluded.

    Evidence date: EIA August 2026 snapshot, released September 24, 2026; reviewed October 20, 2026

    EIA-860M August 2026 inventory (released September 24, 2026)EIA inventory methodology
  • Webberville Solar Project

    Operating · Travis County

    Operating (EIA August 2026); (OP) Operating

    Solar · Solar Photovoltaic · 30 MW generator nameplate

    Location: EIA-reported plant coordinate; not a surveyed boundary

    Operator: FRV AE Solar LLC. EIA sector: IPP Non-CHP. Includes generators reported operating in EIA-860 M; standby, out-of-service, retired and storage units excluded.

    Evidence date: EIA August 2026 snapshot, released September 24, 2026; reviewed October 20, 2026

    EIA-860M August 2026 inventory (released September 24, 2026)EIA inventory methodology
  • Lampe Solar

    Planned / permitting / discussion · Washington County

    Planned (EIA August 2026); (L) Regulatory approvals pending. Not under construction

    Solar · Solar Photovoltaic · 60.2 MW generator nameplate

    Location: EIA-reported plant coordinate; not a surveyed boundary

    Operator: Gransolar Texas Seven LLC. EIA sector: IPP Non-CHP. Developer schedule/status reported to EIA. Planned operation dates and permit activity do not establish construction or commercial operation.

    Evidence date: EIA August 2026 snapshot, released September 24, 2026; reviewed October 20, 2026

    EIA-860M August 2026 inventory (released September 24, 2026)EIA inventory methodology
  • Taylor Technology Campus proposed onsite generation

    Planned / permitting / discussion · Williamson County

    Planned / capacity undisclosed; Planned / capacity undisclosed

    Generation technology unconfirmed · Onsite generation; technology/fuel undisclosed · Capacity unreported / not verified

    Location: Approximate east-Taylor area betweenFM 112 andUS 79; not verified parcel

    Operator: Taylor Technology Campus / PowerHouse BigWatt. City of Taylor describes proposed 665-acre technology/data-center campus east of Taylor betweenFM 112 andUS 79 with its own power generation and surplus delivered to grid. Generation MW and equipment/fuel not confirmed here. Approximate area marker, not surveyed parcel or generator pad.

    Evidence date: Reviewed October 20, 2026

    City of Taylor official campus information
Data center campuses
  • Amazon Data Services Cedar Creek land prospect

    Planned / permitting / discussion · Bastrop County

    Early discussion / land prospect; construction commitment not established

    Large-scale data center campus · Capacity not publicly established in this inventory

    Location: Cedar Creek area; exact public address not established here. Approximate Cedar Creek area marker only; exact project footprint not confirmed.

    Amazon subsidiary bought roughly 1,229–1,300 acres in May 2026. Land acquisition and due diligence are not a confirmed construction commitment.

    Power: Power arrangements not verified.

    Evidence date: Reviewed 2026-10-20; source records have their own publication or filing dates

    Land purchase reportingCorroborating report
  • EDCAUS31–32 / EdgeConneX-associated campus filings

    Planned / permitting / discussion · Bastrop County

    Planned / permitting

    Large-scale data center campus · Capacity not publicly established in this inventory

    Location: 6543 FM 535, Cedar Creek. Existing map address locator at 6543 FM 535 for EDCAUS31–32; not building footprints.

    TDLR registrations for one-story data centers; EDCAUS31 filing is 576,777 sq ft. October 2026 start is a filing schedule, not verified mobilization. EdgeConneX association is reported; TDLR owner is Uppingham Adams Holdings LLC.

    Power: Nearby Fort Worth Power Core / Burr generation project requires separate treatment; shared location does not prove a dedicated campus power relationship.

    Evidence date: Reviewed 2026-10-20; source records have their own publication or filing dates

    TDLR EDCAUS31Filing reporting
  • EdgeConneX Austin campus (AUS01–04 / Wolf Lane)

    Under construction · Bastrop County

    Under construction

    Large-scale data center campus · Up to 336 MW potential (operator plan)

    Location: 6752 FM 535 / 8001 Wolf Lane, Cedar Creek. Existing map address locator for Campus 1 / AUS02; not a building footprint.

    Initial campus is under development/construction; later phases remain planned. Operator brochure markets 96 MW first phase and 336 MW potential; neither is confirmed energized capacity.

    Power: Grid supply; routine backup generation is not mapped as a separate utility-scale power plant.

    Evidence date: Reviewed 2026-10-20; source records have their own publication or filing dates

    EdgeConneX Austin brochureTDLR AUS02 registrationFiling and campus reporting
  • EdgeConneX Cedar Creek Campus 2 / EDCAUS11–16 filings

    Planned / permitting / discussion · Bastrop County

    Planned / permitting

    Large-scale data center campus · Capacity not publicly established in this inventory

    Location: 6682 and 6402 FM 535, Cedar Creek. Filed address locator at 6682 FM 535; Campus 2 also has filings at 6402 FM 535. Existing map shows both.

    Six-building filing group with two addresses: EDCAUS11–14 at 6682 FM 535 and EDCAUS15–16 at 6402 FM 535. This regional pin uses 6682 FM 535. The existing Filed project locators layer shows both address points. Filed start dates do not prove construction.

    Power: A separate nearby energy-center registration exists; do not infer that every EdgeConneX campus has a dedicated plant.

    Evidence date: Reviewed 2026-10-20; source records have their own publication or filing dates

    TDLR EDCAUS11TDLR EDCAUS15Texas Comptroller data center list
  • Greenport / 5C AUS01 industrial data center campus

    Operating · Bastrop County

    Operating

    Industrial computing / cryptocurrency campus with AI development where described · 150 MW planned AI campus

    Location: 2048 FM 969, Elgin (Bastrop County). Census address geocode (approximate street/entrance point); not a surveyed building or project boundary.

    Existing industrial/crypto site with a proposed 150 MW hyperscale AI redevelopment. Current operating use must be distinguished from the full AI buildout.

    Power: Greenport developer describes integrated on-site generation, but full campus power capacity, generation status and relation to 5 C require facility-specific verification.

    Evidence date: Reviewed 2026-10-20; source records have their own publication or filing dates

    Project manager AUS01 description5C facilitiesGreenport developer overview
  • Pacifico / BlackChamber Cedar Creek campus (Project Longhorn)

    Planned / permitting / discussion · Bastrop County

    Planned / permitting

    Large-scale data center campus · Capacity not publicly established in this inventory

    Location: 382 Earl Callahan Road, Cedar Creek. Approximate proposed campus area within the existing filed tract outline; not equipment placement.

    Proposed data center campus. The reported pause and pending air-permit process do not establish cancellation. The existing Pacifico layer shows the filed tracts.

    Power: Proposed on-site Pacifico gas generation. Power-plant nameplate capacity is distinct from data center IT load.

    Evidence date: Reviewed 2026-10-20; source records have their own publication or filing dates

    Lost Pines Watch project recordsApplicant J0049 record
  • Meta Temple Data Center

    Operating · Bell County

    Operating

    Large-scale data center campus · Capacity not publicly established in this inventory

    Location: Industrial Boulevard / Eberhardt Road area, Temple. Approximate Temple industrial-campus vicinity.

    Meta announced the Temple Data Center serving traffic July 22, 2026. Later expansion filings do not mean the full ultimate campus is energized.

    Power: Grid-connected; no dedicated on-site utility-scale generating plant verified.

    Evidence date: Reviewed 2026-10-20; source records have their own publication or filing dates

    Meta online announcementMeta Temple announcement
  • Rowan Project Ranger

    Planned / permitting / discussion · Bell County

    Planned / permitting

    Large-scale data center campus · Capacity not publicly established in this inventory

    Location: East Temple; south of BKB/Panda power-plant corridor. Approximate south/east Temple industrial corridor, not a verified building point.

    Operator identifies one building approved in spring 2026. Separate from Project Temple and Stampede.

    Power: Proximity to power plant does not establish a dedicated supply arrangement.

    Evidence date: Reviewed 2026-10-20; source records have their own publication or filing dates

    Rowan local projects
  • Rowan Project Stampede

    Planned / permitting / discussion · Bell County

    Planned / permitting

    Large-scale data center campus · Capacity not publicly established in this inventory

    Location: East Temple; west of Loop 363 corridor. Approximate east Temple industrial corridor, not a verified building point.

    Operator identifies two buildings approved in winter 2026. Exact project coordinates require parcel confirmation; campus pin is approximate.

    Power: Generation arrangements not independently established.

    Evidence date: Reviewed 2026-10-20; source records have their own publication or filing dates

    Rowan local projects
  • Rowan Project Temple campus

    Under construction · Bell County

    Under construction

    Large-scale data center campus · 300 MW Project Temple campus

    Location: 1707–2351 Bob White Road / 1855 Bob White Road, Temple. Census address geocode (approximate street/entrance point); not a surveyed building or project boundary.

    Rowan explicitly announced construction underway January 2026 at its 300 MW Project Temple campus. Third building (Lasso) has a separate approval process; other Rowan Temple projects are not included in this capacity.

    Power: Grid-connected; neighboring power plants alone do not establish dedicated generation.

    Evidence date: Reviewed 2026-10-20; source records have their own publication or filing dates

    Rowan construction announcementRowan local project pageTDLR Building 2
  • CyrusOne SAT1

    Operating · Bexar County

    Operating

    Large-scale data center campus · 9 MW IT capacity

    Location: 9999 Westover Hills Boulevard, San Antonio. Census address geocode (approximate street/entrance point); not a surveyed building or project boundary.

    Operator lists 9 MW IT capacity at existing enterprise colocation facility.

    Power: Grid supply; routine backup generation is not mapped as a separate utility-scale power plant.

    Evidence date: Reviewed 2026-10-20; source records have their own publication or filing dates

    CyrusOne SAT1
  • CyrusOne SAT2–SAT4 campus

    Operating · Bexar County

    Operating

    Large-scale data center campus · 36 MW IT capacity

    Location: 9554 Westover Hills Boulevard, San Antonio. Census address geocode (approximate street/entrance point); not a surveyed building or project boundary.

    Operator lists 36 MW total IT capacity across SAT2–SAT4 campus.

    Power: Grid supply; routine backup generation is not mapped as a separate utility-scale power plant.

    Evidence date: Reviewed 2026-10-20; source records have their own publication or filing dates

    CyrusOne SAT2–SAT4
  • CyrusOne SAT5–SAT6 campus

    Operating · Bexar County

    Operating

    Large-scale data center campus · 33 MW IT capacity

    Location: 14719 Omicron Drive, San Antonio. Census address geocode (approximate street/entrance point); not a surveyed building or project boundary.

    Operator markets 33 MW IT capacity across current development. Later building phases may have separate completion dates.

    Power: Grid supply; routine backup generation is not mapped as a separate utility-scale power plant.

    Evidence date: Reviewed 2026-10-20; source records have their own publication or filing dates

    CyrusOne SAT5–SAT6
  • Microsoft Lambda Drive campus

    Under construction · Bexar County

    Under construction

    Large-scale data center campus · Capacity not publicly established in this inventory

    Location: Lambda Drive, San Antonio. Approximate Lambda Drive corridor; not a verified building point.

    Microsoft describes first phase of campus development with construction contractor; no current operating-capacity claim.

    Power: Grid supply; routine backup generation is not mapped as a separate utility-scale power plant.

    Evidence date: Reviewed 2026-10-20; source records have their own publication or filing dates

    Microsoft construction update
  • Microsoft San Antonio Rogers Road campus

    Operating · Bexar County

    Operating

    Large-scale data center campus · Capacity not publicly established in this inventory

    Location: 5150–5200 Rogers Road, San Antonio. Census address geocode (approximate street/entrance point); not a surveyed building or project boundary.

    Established Microsoft data center campus; official community page confirms operating Bexar County facilities. Campus capacity undisclosed here.

    Power: Grid supply; routine backup generation is not mapped as a separate utility-scale power plant.

    Evidence date: Reviewed 2026-10-20; source records have their own publication or filing dates

    Microsoft Greater San AntonioMicrosoft Texas overview
  • Microsoft Westover Link campus

    Under construction · Bexar County

    Under construction

    Large-scale data center campus · Capacity not publicly established in this inventory

    Location: Westover Link, San Antonio. Approximate Westover Link corridor; not a verified building point.

    Microsoft confirms clearing and excavation begun. Exact current operational milestone not established.

    Power: Grid supply; routine backup generation is not mapped as a separate utility-scale power plant.

    Evidence date: Reviewed 2026-10-20; source records have their own publication or filing dates

    Microsoft construction update
  • Microsoft Wiseman Boulevard campus

    Under construction · Bexar County

    Under construction

    Large-scale data center campus · Capacity not publicly established in this inventory

    Location: Wiseman Boulevard, west San Antonio. Approximate Wiseman Boulevard corridor; not a verified building point.

    Microsoft explicitly confirms construction begun; an estimated March 2026 completion date does not establish operation.

    Power: Grid supply; routine backup generation is not mapped as a separate utility-scale power plant.

    Evidence date: Reviewed 2026-10-20; source records have their own publication or filing dates

    Microsoft construction update
  • QTS San Antonio 2

    Operating · Bexar County

    Operating

    Large-scale data center campus · 90 MW+ marketed critical campus capacity

    Location: 8535 Potranco Road, San Antonio. Approximate community/corridor point; not a verified building or project boundary.

    Existing 32-acre campus; operator markets 90 MW+ critical campus capacity. Marketed capacity is not actual measured power use.

    Power: Grid-connected; no dedicated on-site utility-scale generation established.

    Evidence date: Reviewed 2026-10-20; source records have their own publication or filing dates

    QTS campus
  • Stream SATB / San Antonio III–VII campus

    Under construction · Bexar County

    Under construction

    Large-scale data center campus · 200 MW planned campus IT capacity

    Location: 11203 Military Drive West, San Antonio. Census address geocode (approximate street/entrance point); not a surveyed building or project boundary.

    Operator markets up to five buildings /200 MW full build, with first facility fully leased. Website also describes construction, so current energized portion is not independently established.

    Power: CPS grid service via on-site 334 MW substation; substation capacity is not generation.

    Evidence date: Reviewed 2026-10-20; source records have their own publication or filing dates

    Stream SATB campus
  • Tract Applewhite Technology Park

    Planned / permitting / discussion · Bexar County

    Planned / permitting

    Large-scale data center campus · Up to 720 MW design capacity

    Location: South San Antonio, Old Applewhite Road area. Approximate Old Applewhite Road corridor south of San Antonio.

    Developer lists 339 acres owned and in development with site design supporting 720 MW. Planned industrial/data-center land, not an operating data center.

    Power: Project-specific generation arrangement not established.

    Evidence date: Reviewed 2026-10-20; source records have their own publication or filing dates

    Tract Applewhite
  • Vantage TX1 campus (TX11–TX12)

    Under construction · Bexar County

    Under construction

    Large-scale data center campus · 128 MW combined filed IT capacity

    Location: 14720 / 17420 Omicron Drive, San Antonio. Census address geocode (approximate street/entrance point); not a surveyed building or project boundary.

    TDLR TX11 inspection complete and TX12 review complete; full campus operating status is not established here. TX11 32 MW and TX12 96 MW are filed capacities.

    Power: On-site gas generation has been reported for Vantage TX1; verify facility-specific TCEQ records before adding a power-layer point.

    Evidence date: Reviewed 2026-10-20; source records have their own publication or filing dates

    TDLR TX11TDLR TX12
  • Vantage TX2 campus (TX21–TX22)

    Planned / permitting / discussion · Bexar County

    Planned / permitting

    Large-scale data center campus · Capacity not publicly established in this inventory

    Location: 5207 Rogers Road, San Antonio. Census address geocode (approximate street/entrance point); not a surveyed building or project boundary.

    TCEQ operating-permit proceeding and state data center tax listing identify TX2. Full construction/operational status not independently resolved; marked planned/permitting.

    Power: Reported on-site gas power project; needs facility-specific TCEQ verification.

    Evidence date: Reviewed 2026-10-20; source records have their own publication or filing dates

    Texas Comptroller listingTCEQ hearing
  • Edged Austin / Maxwell campus

    Planned / permitting / discussion · Caldwell County

    Planned / permitting

    Large-scale data center campus · Capacity not publicly established in this inventory

    Location: 11255 Highway 142, Maxwell. Approximate 11255 Highway 142 address location.

    Caldwell County approved agreements for two phases on approximately 330 acres. First TDLR building is 869,684 sq ft. June 2026 start date is scheduled, not proof of actual construction.

    Power: Related Caldwell Power Generation Plant filing 185697 was identified in prior research; capacity/status requires TCEQ verification. Adjacent LCRA Timmerman plant is separate.

    Evidence date: Reviewed 2026-10-20; source records have their own publication or filing dates

    Caldwell County approval recapTDLR filing
  • Prime Austin AUS01 campus (Project Snow)

    Planned / permitting / discussion · Caldwell County

    Planned / permitting

    Large-scale data center campus · 384 MW critical power at full buildout

    Location: 1395 Bob White Road, Lockhart. Approximate community/corridor location; not a surveyed site boundary.

    Eight-building campus marketed at 384 MW critical power. May 2026 TDLR filing covers first two 380,000 sq ft shells with a June 2026 target start; work start not independently verified.

    Power: Bluebonnet Electric service and planned on-site substation. No dedicated utility-scale generating plant verified.

    Evidence date: Reviewed 2026-10-20; source records have their own publication or filing dates

    Prime AustinPrime specification sheetTDLR first two buildings
  • Tract Caldwell Valley Technology Park

    Planned / permitting / discussion · Caldwell County

    Planned / permitting

    Large-scale data center campus · Up to 4,000 MW planned capacity

    Location: Caldwell Valley / Uhland area. Approximate community/corridor location; not a surveyed site boundary.

    2,973-acre master-planned technology park; developer markets up to 4,000 MW of data center capacity and 2028 energization. This is potential full buildout, not operating load. Reported PowerHouse proposal for roughly 500 acres is within this park; included here to avoid duplicate campus counting.

    Power: Developer states combination of grid interconnection and on-site natural gas generation; generation capacity not disclosed in these sources.

    Evidence date: Reviewed 2026-10-20; source records have their own publication or filing dates

    Tract projectTract January 2026 expansionPowerHouse proposal reporting
  • Geronimo Power Ammannsville–Dubina data center discussions

    Planned / permitting / discussion · Fayette County

    Early discussion / land prospect; construction commitment not established

    Large-scale data center campus · Capacity not publicly established in this inventory

    Location: Ammannsville–Dubina area. Ammannsville community center only; not the project site.

    Local reporting describes a potential AI data center. No exact address, committed capacity or construction evidence verified; retain as early discussion.

    Power: Project-specific generation arrangement not verified.

    Evidence date: Reviewed 2026-10-20; source records have their own publication or filing dates

    Fayette County Record reporting
  • PlaceMKR / La Grange-Winchester data center proposal

    Planned / permitting / discussion · Fayette County

    Early discussion / land prospect; construction commitment not established

    Large-scale data center campus · Capacity not publicly established in this inventory

    Location: FM 448 north of Winchester, near Piney Creek Ranch. Approximate FM 448 vicinity north of Winchester; no verified street address or project boundary.

    Reported lease/option for more than 400 acres north of Winchester. Capacity and construction commitment are undisclosed.

    Power: Power arrangements unknown.

    Evidence date: Reviewed 2026-10-20; source records have their own publication or filing dates

    Fayette County Record reporting
  • CloudBurst / Evolve San Marcos Data Center I

    Under construction · Guadalupe County

    Under construction

    Large-scale data center campus · Up to 1,200 MW planned campus

    Location: 2955 Francis Harris Lane / San Marcos–New Braunfels corridor. Census address geocode (approximate street/entrance point); not a surveyed building or project boundary.

    Developer/Evolve announced groundbreaking November 5, 2025 for a phased 1.2 GW AI campus; full buildout and future energization are not current operation.

    Power: Developer plans on-site natural gas generation; firm gas supply agreement contingent on customer final investment decision.

    Evidence date: Reviewed 2026-10-20; source records have their own publication or filing dates

    Evolve groundbreaking announcementCloudBurst gas agreement
  • Sabey / Carson Select San Marcos proposal

    Planned / permitting / discussion · Hays County

    Planned / permitting

    Large-scale data center campus · Capacity not publicly established in this inventory

    Location: Old Bastrop Road / Francis Harris Lane corridor. Approximate corridor southeast of Old Bastrop Road / Francis Harris Lane.

    Proposed development on 786 acres included data centers, open space and other uses. Discussion/negotiation stage; current full entitlements and construction not verified.

    Power: Nearby Hays Energy plant is separate; no dedicated generating project established.

    Evidence date: Reviewed 2026-10-20; source records have their own publication or filing dates

    San Marcos June 3, 2025 agendaProposal reporting
  • Cipher Digital McLennan / Riesel campus proposal

    Planned / permitting / discussion · McLennan County

    Planned / permitting

    Large-scale data center campus · Up to 500 MW targeted power capacity

    Location: Rattlesnake Road near Sandy Creek power plant, Riesel. Approximate community/corridor point; not a verified building or project boundary.

    SEC filing targets up to 500 MW with estimated 2028 energization, subject to ERCOT process. Local reporting places roughly 300 acres near Sandy Creek plant; neighboring plant is not a dedicated-supply guarantee.

    Power: Grid-connected; no dedicated on-site utility-scale generation established.

    Evidence date: Reviewed 2026-10-20; source records have their own publication or filing dates

    Cipher SEC annual reportCipher infrastructureLocal site reporting
  • Galaxy Merlin AI / HPC campus

    Planned / permitting / discussion · McLennan County

    Planned / permitting

    Large-scale data center campus · 74 MW initial development phase (planned)

    Location: McGregor Industrial Park, McGregor. Approximate McGregor Industrial Park vicinity; exact 500-acre site boundary not verified.

    Galaxy announced acquisition of approximately 500 acres on July 28, 2026 under a City development agreement for an AI/HPC campus. Do not confuse with the operating Helios campus in Dickens County. Operator targets initial 74 MW power in 2028, with later growth subject to transmission infrastructure.

    Power: Heart of Texas Electric Cooperative utility interconnection and private on-site substation; no dedicated generating plant announced in the acquisition release.

    Evidence date: Reviewed 2026-10-20; source records have their own publication or filing dates

    Galaxy acquisition announcement
  • Infrakey Lacy Lakeview Data District (L2D2)

    Planned / permitting / discussion · McLennan County

    Planned / permitting

    Large-scale data center campus · 925 MW planned total /170 MW phase 1

    Location: Lacy Lakeview north of Waco. Approximate community/corridor point; not a verified building or project boundary.

    Developer markets 925 MW total on 520 acres, with 170 MW first phase. Current operator timeline lists November 15, 2026 construction start and December 2027 HV energization; both are future targets.

    Power: Developer lists HILCO electric framework and on-site substation; separate gas-generation discussions reported but project-specific plant not established here.

    Evidence date: Reviewed 2026-10-20; source records have their own publication or filing dates

    Infrakey campus and timelineOperator January 2026 announcement
  • Bitdeer Rockdale campus — crypto / proposed AI conversion

    Operating · Milam County

    Operating

    Industrial computing / cryptocurrency campus with AI development where described · 563 MW electrical capacity (crypto campus)

    Location: Former Alcoa industrial area near Rockdale. Approximate Bitdeer industrial campus vicinity.

    Existing cryptocurrency data center, 563 MW electrical capacity in use in March 2026. September update reports 200 acres acquired nearby for AI/HPC development; AI expansion remains prospective.

    Power: Grid-connected Alcoa private power network.

    Evidence date: Reviewed 2026-10-20; source records have their own publication or filing dates

    Bitdeer 2025 Form 20-FBitdeer September 2026 update
  • Riot Rockdale campus — crypto operation / AI conversion

    Operating · Milam County

    Operating

    Industrial computing / cryptocurrency campus with AI development where described · 191 MW contracted AI expansion (future delivery)

    Location: Former Alcoa industrial area near Rockdale. Approximate former Alcoa / Riot campus vicinity.

    Existing large Bitcoin-mining campus. SEC August 10, 2026 release confirms a 191 MW critical IT AI lease with staged future delivery; the planned AI capacity must not be labeled fully operating.

    Power: Grid-connected private power network. Do not label the separate 1,200 MW Lee County Sandow Lakes plant as proven dedicated power for this campus.

    Evidence date: Reviewed 2026-10-20; source records have their own publication or filing dates

    Riot SEC August 2026 release
  • Core Scientific Austin 1

    Operating · Travis County

    Operating

    Large-scale data center campus · 20 MW operator marketed total power

    Location: 3301 Hibbetts Road, Austin. Census address geocode (approximate street/entrance point); not a surveyed building or project boundary.

    Operator markets 20 MW total power and a 38-acre campus. Financing disclosure describes 16.5 MW data halls, so capacity bases differ.

    Power: Grid supply; routine backup generation is not mapped as a separate utility-scale power plant.

    Evidence date: Reviewed 2026-10-20; source records have their own publication or filing dates

    Core Scientific AustinCore Scientific financing disclosure
  • CyrusOne Austin AUS2–AUS3 campus

    Operating · Travis County

    Operating

    Large-scale data center campus · 19 MW IT capacity

    Location: 7100–7301 Metropolis Drive, Austin. Census address geocode (approximate street/entrance point); not a surveyed building or project boundary.

    Operator lists 19 MW total IT capacity and 242,000 sq ft technical space across AUS2–AUS3.

    Power: Grid supply; routine backup generation is not mapped as a separate utility-scale power plant.

    Evidence date: Reviewed 2026-10-20; source records have their own publication or filing dates

    CyrusOne Austin
  • Digital Realty AUS11

    Operating · Travis County

    Operating

    Large-scale data center campus · Capacity not publicly established in this inventory

    Location: 7500 Metro Center Drive, Austin. Census address geocode (approximate street/entrance point); not a surveyed building or project boundary.

    Existing major colocation site; capacity not independently confirmed in operator page.

    Power: Grid supply; routine backup generation is not mapped as a separate utility-scale power plant.

    Evidence date: Reviewed 2026-10-20; source records have their own publication or filing dates

    Digital Realty Austin
  • Skybox Austin I–II / Prologis Pflugerville campus

    Operating · Travis County

    Operating

    Large-scale data center campus · 30 MW Austin I utility capacity

    Location: 600 New Meister Lane / 2515 S Kenney Fort Boulevard, Pflugerville. Approximate New Meister Lane campus vicinity.

    Austin I is an existing 30 MW utility /20 MW critical facility; nearby Austin II is a separately filed expansion. Do not treat both buildout capacities as currently operating.

    Power: Grid supply; routine backup generation is not mapped as a separate utility-scale power plant.

    Evidence date: Reviewed 2026-10-20; source records have their own publication or filing dates

    Skybox Austin ISkybox Austin marketTDLR Austin II
  • Switch / Data Foundry Texas 1–2 Data Ranch

    Operating · Travis County

    Operating

    Large-scale data center campus · Capacity not publicly established in this inventory

    Location: 4100 Smith School Road, Austin. Census address geocode (approximate street/entrance point); not a surveyed building or project boundary.

    Existing Data Foundry Austin colocation campus, acquired by Switch in 2021. Separate from The Rock campus in Round Rock.

    Power: Grid supply; routine backup generation is not mapped as a separate utility-scale power plant.

    Evidence date: Reviewed 2026-10-20; source records have their own publication or filing dates

    Switch Austin existing Data Foundry assets
  • Amazon Round Rock optional data center land use

    Planned / permitting / discussion · Williamson County

    Early discussion / land prospect; construction commitment not established

    Large-scale data center campus · Capacity not publicly established in this inventory

    Location: Southwest corner of County Road 172 and McNeil Road. Approximate named road/intersection vicinity; not a verified building or parcel boundary.

    149-acre Amazon logistics property allows a future data center and substation in its PUD. City states no data center construction plans submitted. This is a land-use option, not an announced operating campus.

    Power: Grid supply; no primary on-site utility-scale generation established.

    Evidence date: Reviewed 2026-10-20; source records have their own publication or filing dates

    Round Rock Amazon zoningRound Rock current project information
  • Blueprint Georgetown data center

    Planned / permitting / discussion · Williamson County

    Planned / permitting

    Large-scale data center campus · 25 MW gross utility capacity (planned)

    Location: Westinghouse Road corridor, Georgetown. Approximate Westinghouse Road corridor marker; not a verified property point.

    Operator markets 25 MW gross utility capacity and 2026–2027 energization. No current operation independently verified.

    Power: Grid supply; routine backup generation is not mapped as a separate utility-scale power plant.

    Evidence date: Reviewed 2026-10-20; source records have their own publication or filing dates

    Blueprint projects
  • Blueprint Taylor data center

    Planned / permitting / discussion · Williamson County

    Planned / permitting

    Large-scale data center campus · 60 MW gross utility capacity (planned)

    Location: Taylor, near Samsung campus. Taylor area marker; exact parcel/address not verified here.

    Operator markets 60 MW gross utility capacity and 2026–2027 energization. Development does not establish that the facility is operating.

    Power: Grid supply; routine backup generation is not mapped as a separate utility-scale power plant.

    Evidence date: Reviewed 2026-10-20; source records have their own publication or filing dates

    Blueprint projects
  • Colovore AUS01 Hutto

    Planned / permitting / discussion · Williamson County

    Planned / permitting

    Large-scale data center campus · 40 MW planned IT capacity

    Location: 2401 Innovation Boulevard, Hutto. Approximate Innovation Boulevard address vicinity.

    Operator markets five 8 MW halls, 40 MW total, pre-leasing 2026–2027. September TDLR registration targets future construction; no actual start verified.

    Power: Grid supply; routine backup generation is not mapped as a separate utility-scale power plant.

    Evidence date: Reviewed 2026-10-20; source records have their own publication or filing dates

    Colovore AustinTDLR registration
  • KDC Project Comal Taylor campus

    Planned / permitting / discussion · Williamson County

    Planned / permitting

    Large-scale data center campus · Capacity not publicly established in this inventory

    Location: 1051 County Road 401, Taylor. Approximate named road/intersection vicinity; not a verified building or parcel boundary.

    City identifies approximately 210 acres northeast of Samsung as a proposed data center development. Project-specific site approvals do not establish operating capacity.

    Power: Grid supply; no primary on-site utility-scale generation established.

    Evidence date: Reviewed 2026-10-20; source records have their own publication or filing dates

    City of Taylor Project Comal
  • Sabey SDC Austin campus

    Operating · Williamson County

    Operating

    Large-scale data center campus · 84 MW campus buildout

    Location: 1300 Louis Henna Boulevard, Round Rock. Census geocoded address point; approximate campus entrance, not building footprint.

    Existing campus with Building B under construction in Q1 2026. Operator markets 84 MW campus; Building B is 54 MW. These are buildout figures, not verified current draw.

    Power: Grid supply; routine backup generation is not mapped as a separate utility-scale power plant.

    Evidence date: Reviewed 2026-10-20; source records have their own publication or filing dates

    Sabey campusSabey construction update
  • Skybox / Prologis PowerCampus Austin (Hutto)

    Under construction · Williamson County

    Under construction

    Large-scale data center campus · Up to 600 MW utility power availability

    Location: 3399 County Road 132, Hutto. Census address geocode (approximate street/entrance point); not a surveyed building or project boundary.

    Major campus under development with additional planned buildings; operator markets 600 MW power availability through a private substation. Utility capacity is not measured IT consumption.

    Power: Private on-site substation in Oncor territory; a substation is not an electricity-generating plant.

    Evidence date: Reviewed 2026-10-20; source records have their own publication or filing dates

    Skybox campusSkybox Austin marketTDLR Building 4
  • Skybox Old Settlers Round Rock proposal

    Planned / permitting / discussion · Williamson County

    Planned / permitting

    Large-scale data center campus · 75 MW grid power zoning cap

    Location: East of N A W Grimes Boulevard, south of E Old Settlers Boulevard. Approximate named road/intersection vicinity; not a verified building or parcel boundary.

    Approximately 29.69-acre proposal. City page describes one building capped at 250,000 sq ft and 75 MW grid-interconnected power; cap is not an operating-load claim.

    Power: Grid connected; city restricts generators to supplemental/emergency/reliability uses, rather than normal primary power.

    Evidence date: Reviewed 2026-10-20; source records have their own publication or filing dates

    Round Rock project informationCity zoning record
  • Switch The Rock campus

    Under construction · Williamson County

    Under construction

    Large-scale data center campus · Up to 285 MW on completion

    Location: 300 Dell Way, Round Rock. Approximate Dell Way campus location.

    Switch campus at Dell headquarters; operator phase-two page markets up to 285 MW on completion. Final current operational status was not independently confirmed.

    Power: Grid supply; routine backup generation is not mapped as a separate utility-scale power plant.

    Evidence date: Reviewed 2026-10-20; source records have their own publication or filing dates

    Switch AustinSwitch phase 2Round Rock agreement
  • Taylor Technology Campus (PowerHouse / Big Watt; Project Mustang)

    Planned / permitting / discussion · Williamson County

    Planned / permitting

    Large-scale data center campus · Capacity not publicly established in this inventory

    Location: 664 acres east of Taylor between FM 112 and US 79. Approximate east-Taylor FM 112 / US 79 project corridor.

    Taylor approved the development agreement October 8, 2026. Separate project from Blueprint Taylor. Capacity not specified on the City project page.

    Power: City states on-site generation will serve the project and may sell surplus electricity to the grid.

    Evidence date: Reviewed 2026-10-20; source records have their own publication or filing dates

    City of Taylor project page
Nearby power projects · permitted equipment and emissions records

Permit-record evidence checked October 1, 2026. Keep the two plants separate. Permit limits describe authorized or proposed emissions; they are not measurements of pollution actually released.

FM 535 · Bastrop County Power Plant · registration 178505

The December 20, 2024 issuance authorizes six gas-fired combustion turbine generators and two heat-recovery steam generators. The registration expires December 20, 2034. Construction status is unconfirmed.

The turbine-block annual caps are NOx 92.44, CO 70.25, PM/PM10/PM2.5 62.26, VOC 44.92, formaldehyde 8.40 and ammonia 161.31 tons/year. Additional vent and fugitive emissions are listed separately, so these are not complete facility totals.

TCEQ issuance letter and emissions table

MPH Bastrop Peakers · permits 178585 / PSDTX1658 / GHGPSDTX247

The preliminary determination lists proposed allowable annual emissions of NOx 726.50, CO 613.26, PM/PM10/PM2.5 190.68 and approximately 2.62 million tons CO2e. These preliminary figures still require comparison with the final signed permit limits.

The control analysis uses dry low-NOx combustors and does not select SCR. Routine emissions calculations assume 3,139 hours/year per turbine, excluding startup and shutdown; the SCR cost analysis separately assumes a 40% capacity factor. Those figures are not equivalent.

The document also identifies GEN-1, a 1,881-hp diesel emergency generator, and FWP-1, a diesel fire pump, each with up to 100 hours/year of non-emergency testing and maintenance. These equipment entries belong to MPH, not Pacifico.

TCEQ preliminary determination
SpaceX manufacturing · checked October 1, 2026

Aluminum furnaces and turbine-blade plans

The SX map marker identifies the Starlink factory at 858 FM 1209. The furnace permit and the Bastrop turbine foundry have different documented processes; the available records do not establish that they are the same project.

Explore

858 FM 1209 · aluminum melting and casting

Air permit pending
Process
Two natural-gas-fired melting furnaces and six electric holding furnaces melt clean aluminum ingots for six die-casting machines at the Starlink ground-terminal factory. The application describes melting and casting metal, not producing primary aluminum from ore.
Equipment
The application lists the equipment as already constructed and already operating. Those are applicant statements; they do not establish final permit approval.
Permit 182733
Application received January 16, 2026. TCEQ has completed technical review and issued a draft permit and preliminary decision to issue. The October 15 public meeting is pending; the notice is not a final permit.
Public meeting
October 15, 2026, 7 p.m. Central · Jerry Fay Wilhelm Center for the Performing Arts, 1401 Cedar Street, Bastrop

Bastrop · gas-turbine blades and vanes

Exact parcel unconfirmed
Company evidence
SpaceX's Bastrop job postings describe a new industrial gas-turbine blade and vane manufacturing line and a foundry producing nickel-based superalloy castings for power generation.
Location limit
The SpaceX postings establish Bastrop, but do not identify a parcel or tie the turbine foundry to permit 182733. The factory marker locates the aluminum-permit site; it is not a confirmed turbine-foundry location or footprint.
What this means
The documented plan is component manufacturing. These sources do not establish a gas-fired power plant at this map point, a final foundry permit, or a foundry opening date.

Address check: the permit identifies 858 FM 1209; it does not identify 835 FM 1209. The SX point comes from TCEQ's facility record and is a location reference, not an equipment footprint or a new ownership determination. TCEQ facility location record

Primary geometry sources

Inspect the records behind the map.

Open the source register for the project tracts, appraisal geometry, public-facility records, emergency-response context, and the map's stated limitations.

Explore

The Pacifico project area is not inferred from its street address. Page 7 of J0049 identifies eight exact tracts, and Supplement 1, Figures 2–3, depicts their proposed-project boundary. The map also shows CAD-derived EdgeConneX site tracts, the four current eastern FM 535 host parcels tied by public records to ECX AUS31–36, the power plant and EDCAUS15–16, and the approximately 1,300-acre Amazon assemblage, the 120-acre MPH Bastrop Peakers host parcel, Earth Native's five-parcel property tract and shared line, 20 SpaceX / Gapped Bass parcels and 3 separately labeled resident-reported sales parcels, the corrected 25-facility school and early-childhood register, privacy-safe community context, a dated weekly drought classification, and the Texas FireConnect station record. The Uppingham-owned R34648 and R55674 polygons are dashed to distinguish fee title from direct EdgeConneX ownership and from the EDCAUS31/32 and EDCAUS15/16 filed addresses. Those addresses do not establish building footprints across the full parcels. CAD parcel products are approximate and not surveys; a station location is likewise not presented as proof of staffing, apparatus, response time, water supply, or industrial capability.

Read the geometry carefully.

County parcel data is approximate and not a survey. Project points locate filed addresses, not buildings. The Amazon outline is a historical dissolved CAD parcel assemblage, not a verified current ownership boundary. Current CAD attribution and recorded deed 202607258 require tract-by-tract reconciliation. Solid purple parcels R35120 and R25532 are currently owned by EdgeConneX Property 7; dashed brown parcels R34648 and R55674 are currently owned by Uppingham Adams Holdings. The dashed treatment signals that public records support a project relationship but do not establish direct EdgeConneX ownership or a final project boundary across the full Uppingham acreage. The optional conceptual Pacifico layout has been affinely aligned to fixed features visible in its embedded and reference aerial imagery. It is a georeferenced interpretation, not a survey, construction staking plan, final construction footprint, approval, or as-built record. The MPH outline is the full 120-acre CAD host parcel, not J0033 Supplement 1's 45.395-acre internal project boundary or the proposed six-mile pipeline easement. Earth Native's five polygons show the full owner-identified property tract, not active-use acreage; the highlighted shared line is appraisal geometry, not a survey. Solid SpaceX and Gapped Bass polygons show ownership supported by CAD records checked September 26, 2026, plus recorded-deed evidence for parcel 121670 added September 27. That 83.749-acre parcel is part of the six-parcel, 117.707-acre surveyed SpaceX purchase in deed 202609629, recorded June 8, 2026; this addition maps only parcel 121670. Its CAD owner field still lists the prior owner. Five SpaceX-owned tracts around Doc Bryson Lane total 760.612 legal acres; their development status is unconfirmed. Dashed parcels 35975, 8734540 and 108531 retain earlier SpaceX ownership records because the current CAD service returns blank owner fields. They are excluded from the current-owner acreage total. Parcels 13846 and 73752 are listed under SpaceX; parcels 69963 and 53987 are listed under Gapped Bass II LLC. Parcel ownership does not establish the developed footprint of a phase, and leased land may not appear under an affiliate's name. Dotted amber outlines mark a separate resident-reported sales layer. Parcel 133579 is 314.17 acres and transferred to Colorado River Ranch LLC under deed 202609191, recorded June 1, 2026; the reported Musk connection remains unconfirmed. Bar W Ranch parcels 51141 (453.384 acres) and 35704 (347.862 acres) are labeled resident-reported pending sale. CAD still lists Bar W Ranch Partnership, Ltd.; the pending transaction, buyer identity and any Musk connection are not independently confirmed. All three reported parcels are excluded from confirmed SpaceX / Gapped Bass counts and acreage. Co-located school and childcare markers use tiny display offsets while preserving their true addresses. Fire perimeters are historical, not forecasts. Residential points are anonymized and are not proof of current occupancy. Station points and five-mile guides do not prove staffing, apparatus, drive time, response time, water supply, or industrial-fire capability. Project distance offsets are measurements from Pacifico’s filed perimeter, not impact zones.
